JRO SkyShed Build
March 2019

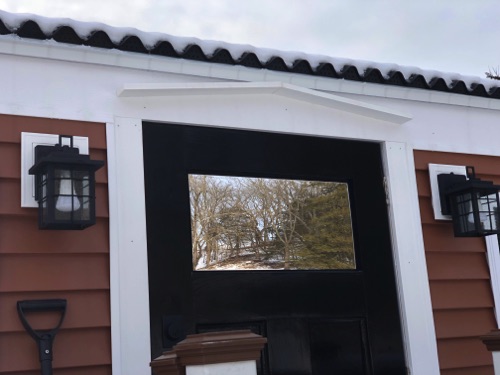

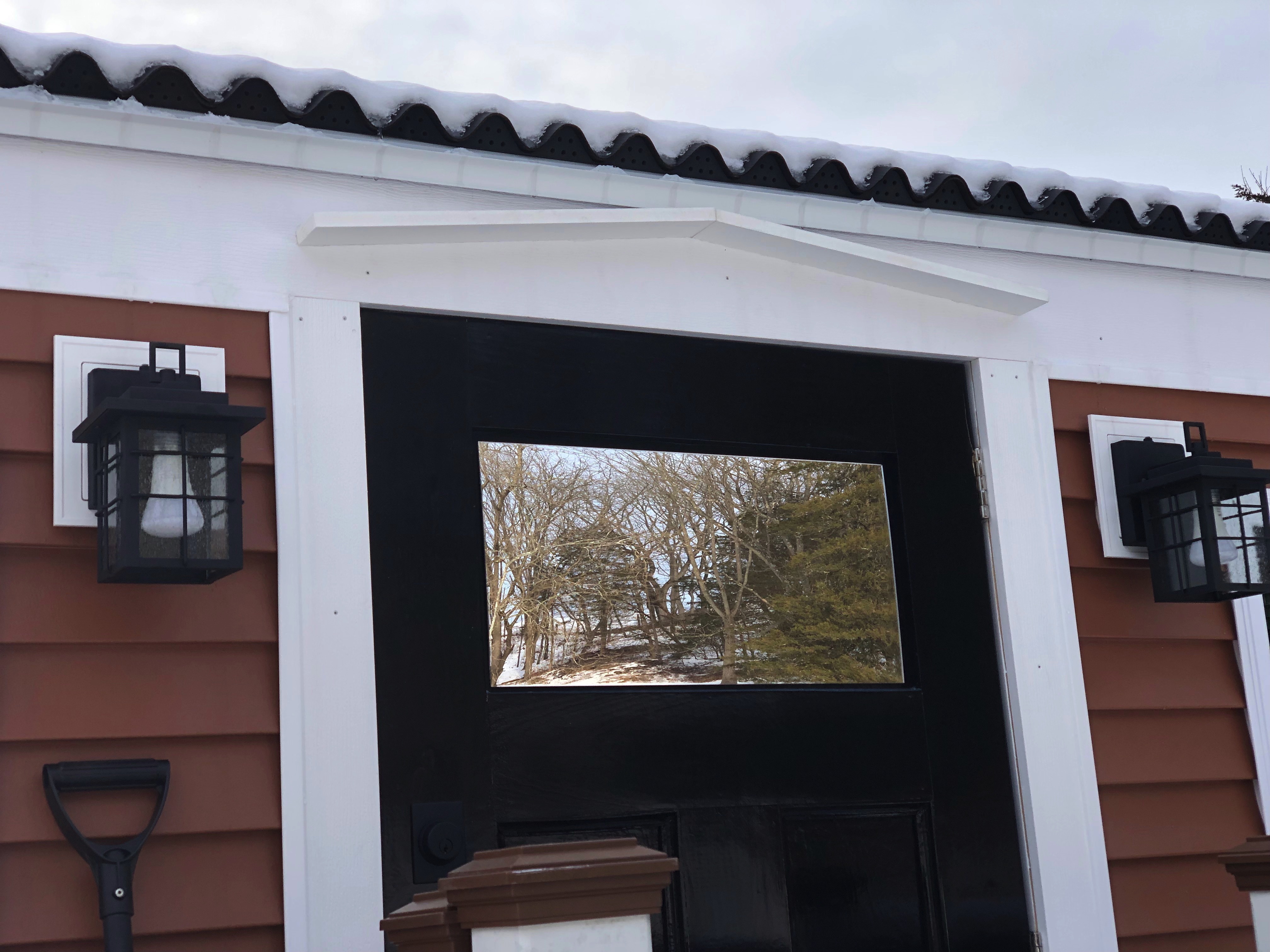

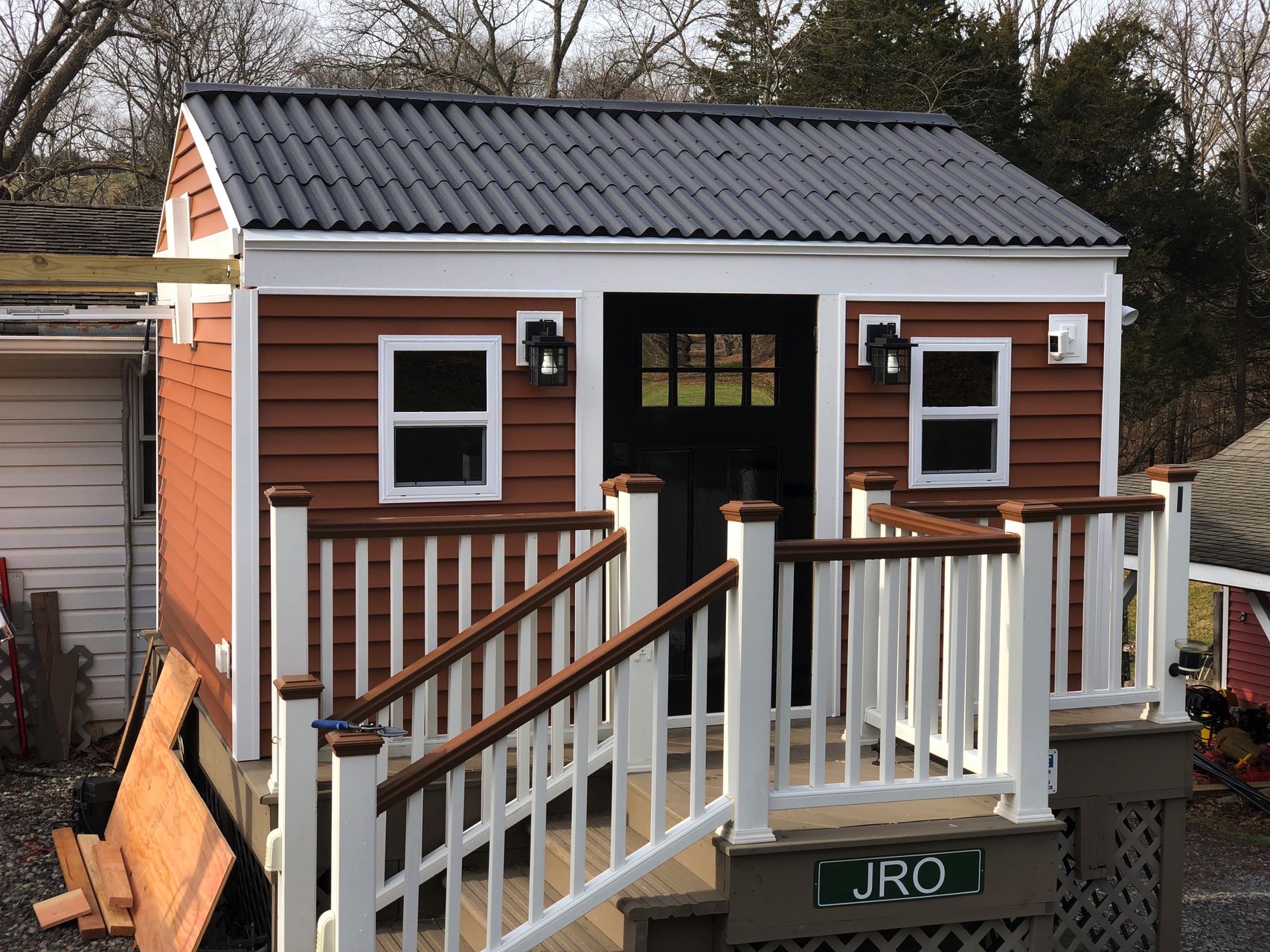

First Light

Finished window & Door Trim
February

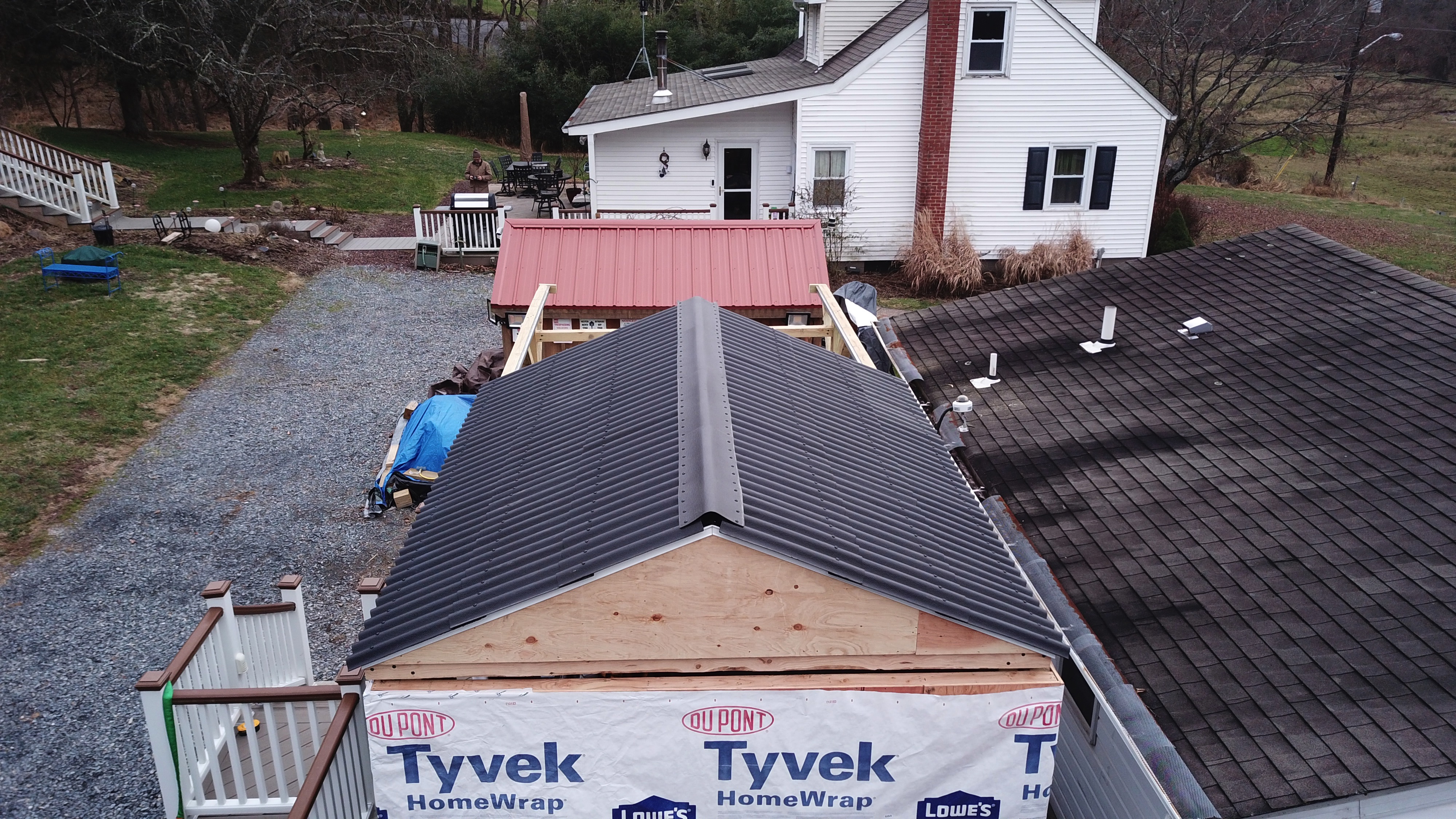

Install SkyRoof
Next version of software underway
Got Mount PC running, connected and updated
Installed and balanced RASA
Installed and leveled CGEPro
Extended Pier (I hope this works!)
Observatory environmental PC back online
SkyAlert online
Setup Network
Finished Window & Door Trim

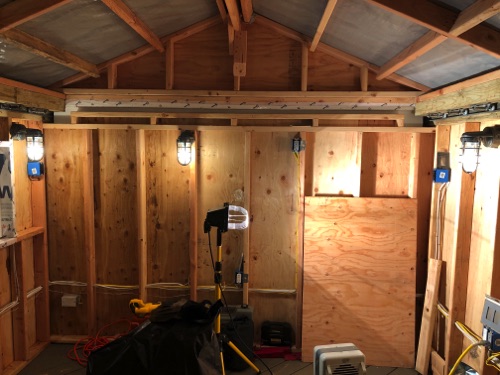

Powered up 12V main bus
Installed Floor Insulation & Floor TileFinished window & Door Trim
Powered up 12V main bus

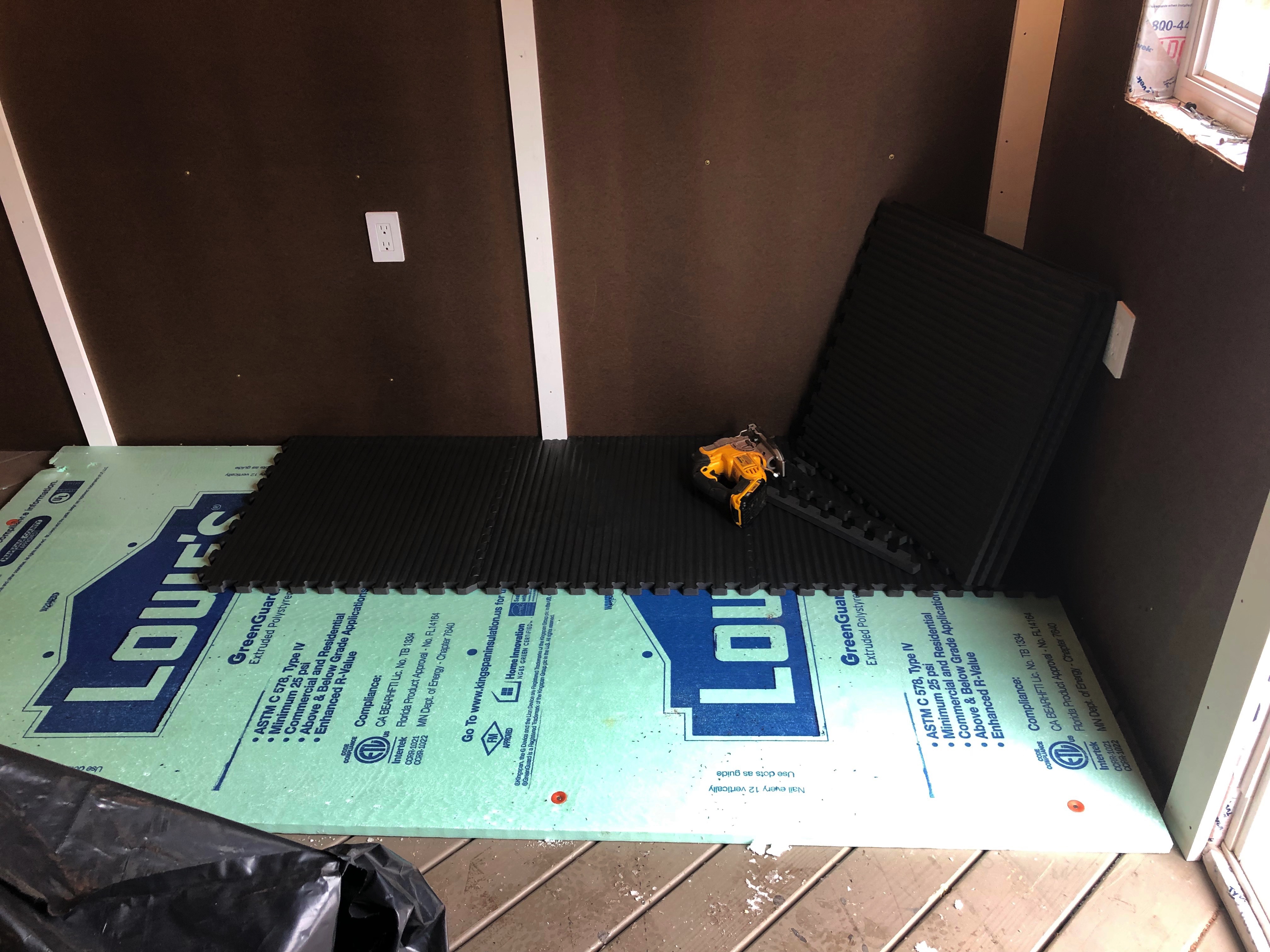

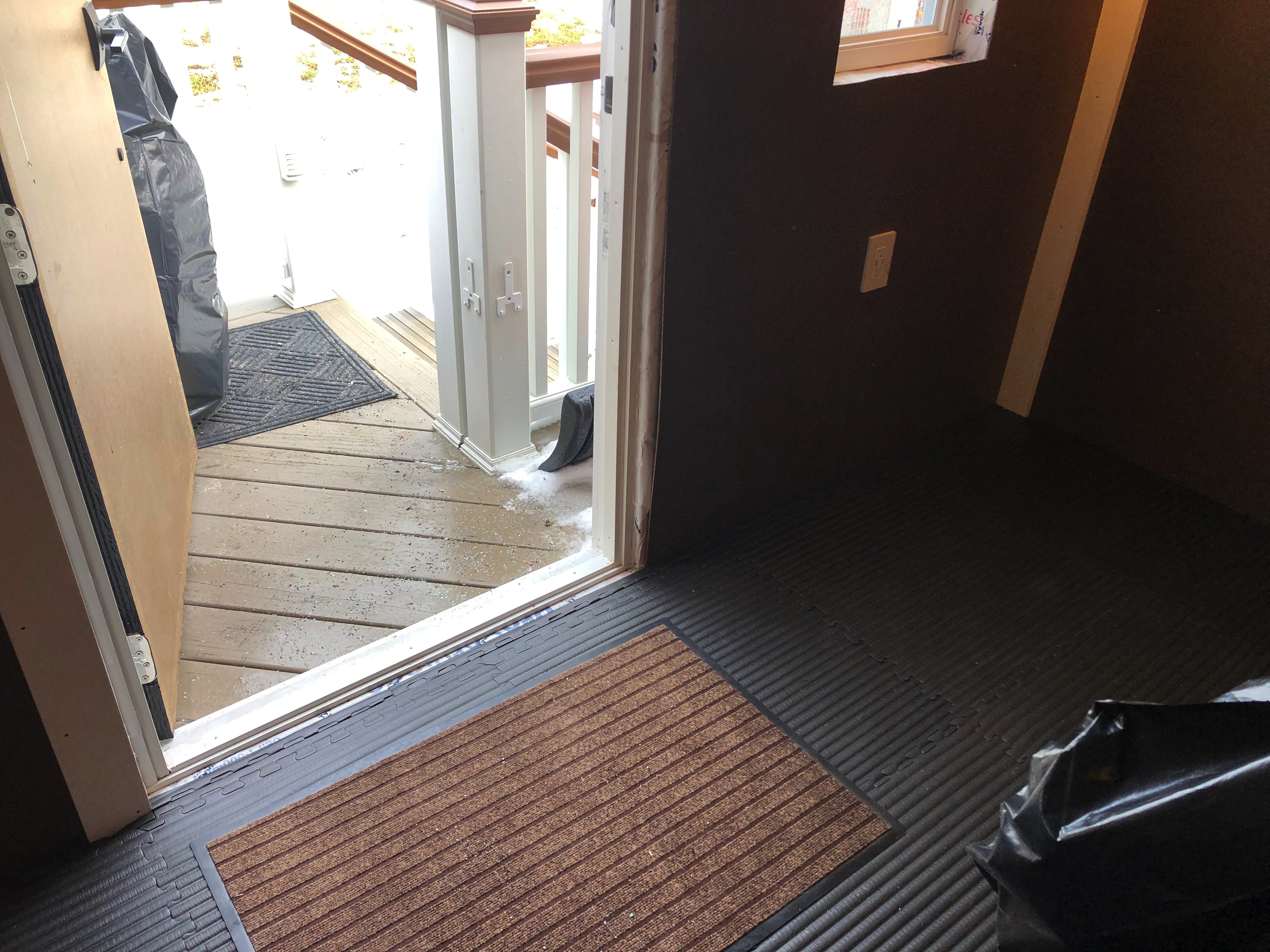

Installed Floor Insulation & Floor Tile
Made reverse gable over door
Prep for floor
January
COLD!

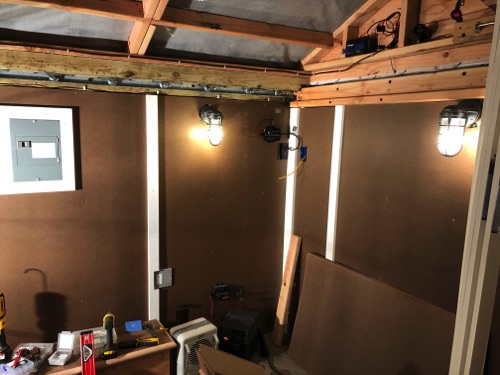

Completed Wallboard installation
Mostly done with Trim except for windows, door and built-ins
The door is not doing well in the weather, water has infiltrated the mullion and one of the stiles. I'm going to make a small reverse gable over the
door to protect it from roof run off and then fix the door.

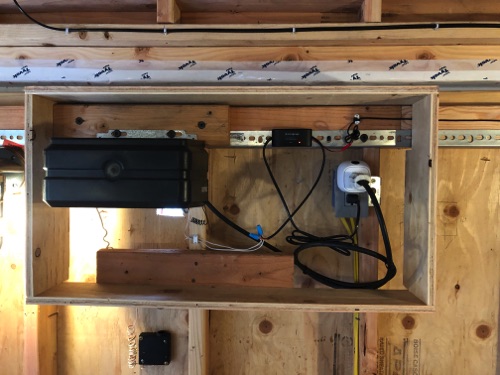

Boxed in Roof Opener
Details details details
Prep for Floor and Wallboard

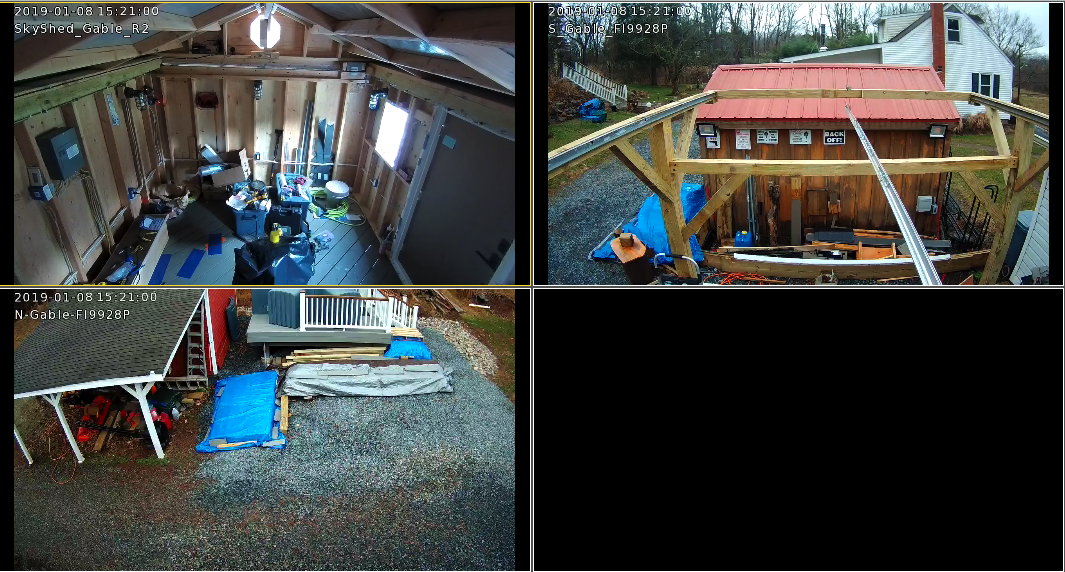

1 of 3 Inside Gables cam installed

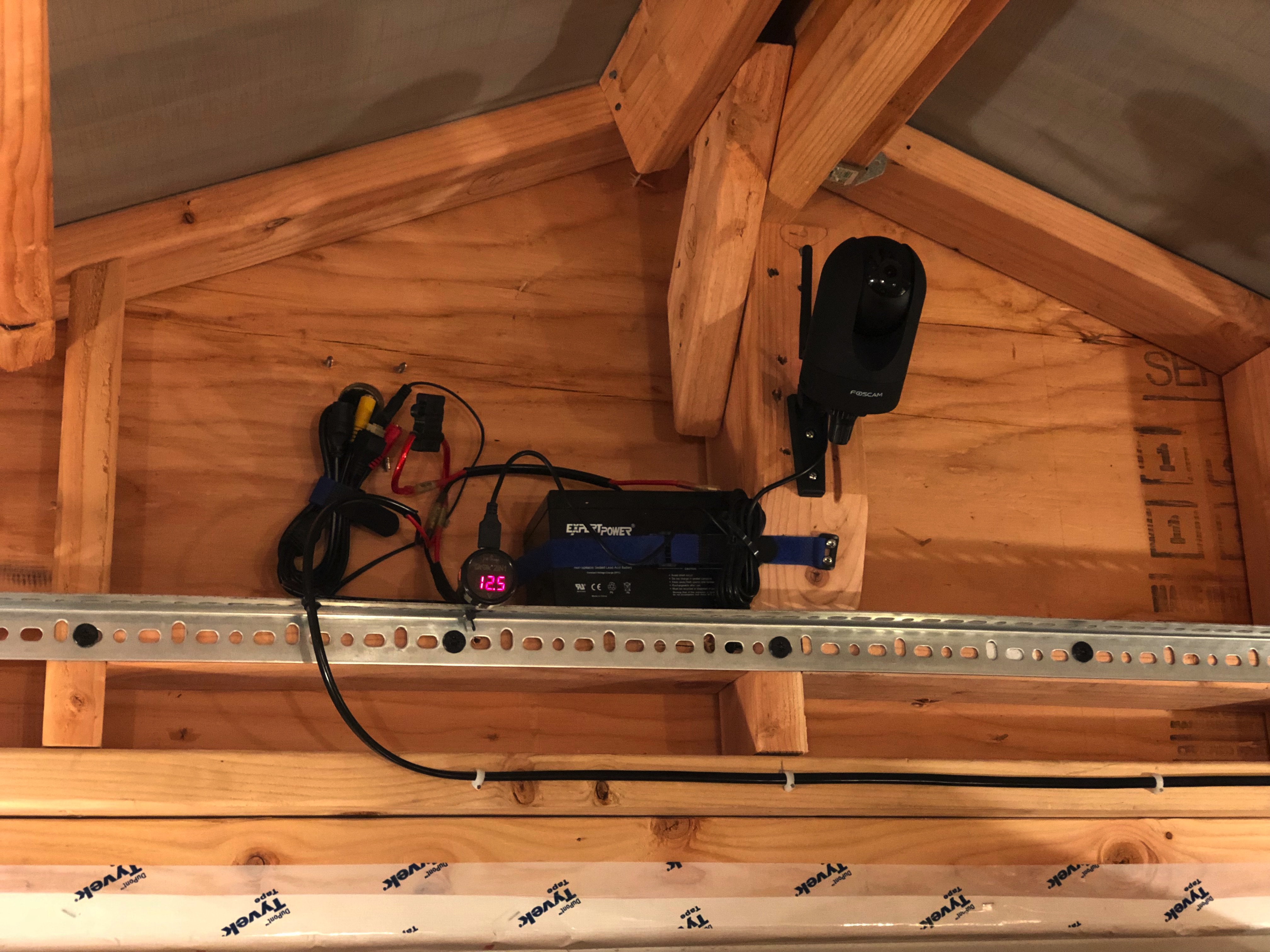

Gable batteries and charger installed
Foscam Cameras installed

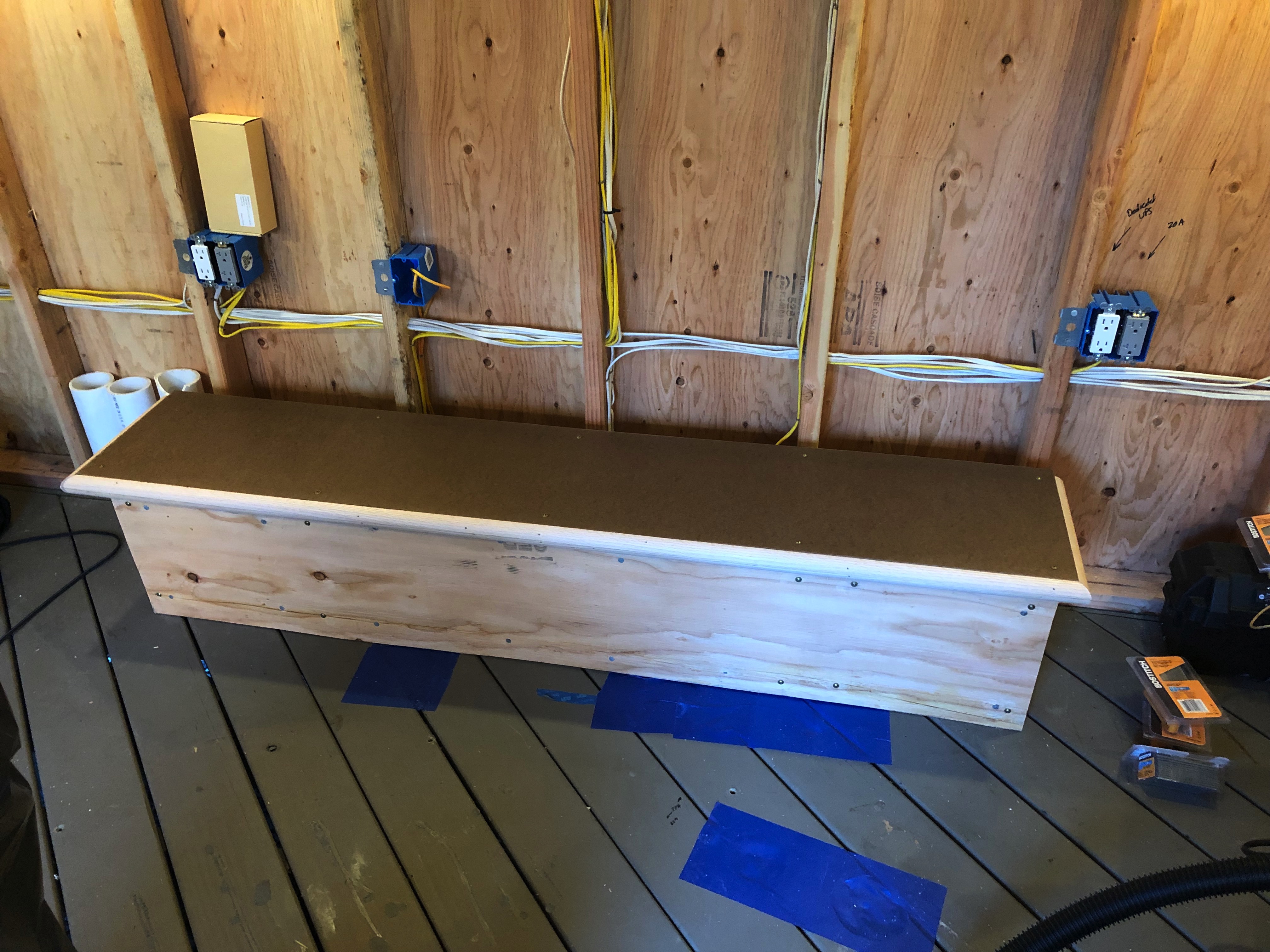

Made access box for connections from/to the garage for electrical and LAN
Created a 3" PVC Conduit between the pier and the access box
Finish Exterior Flashing & Caulking
December

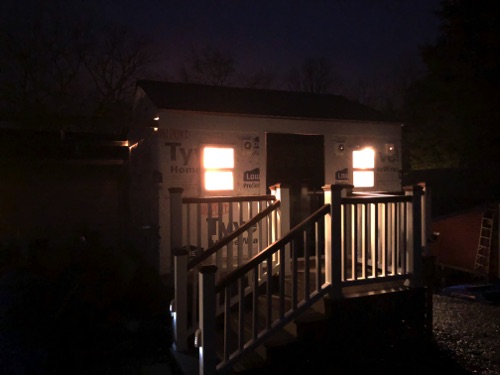

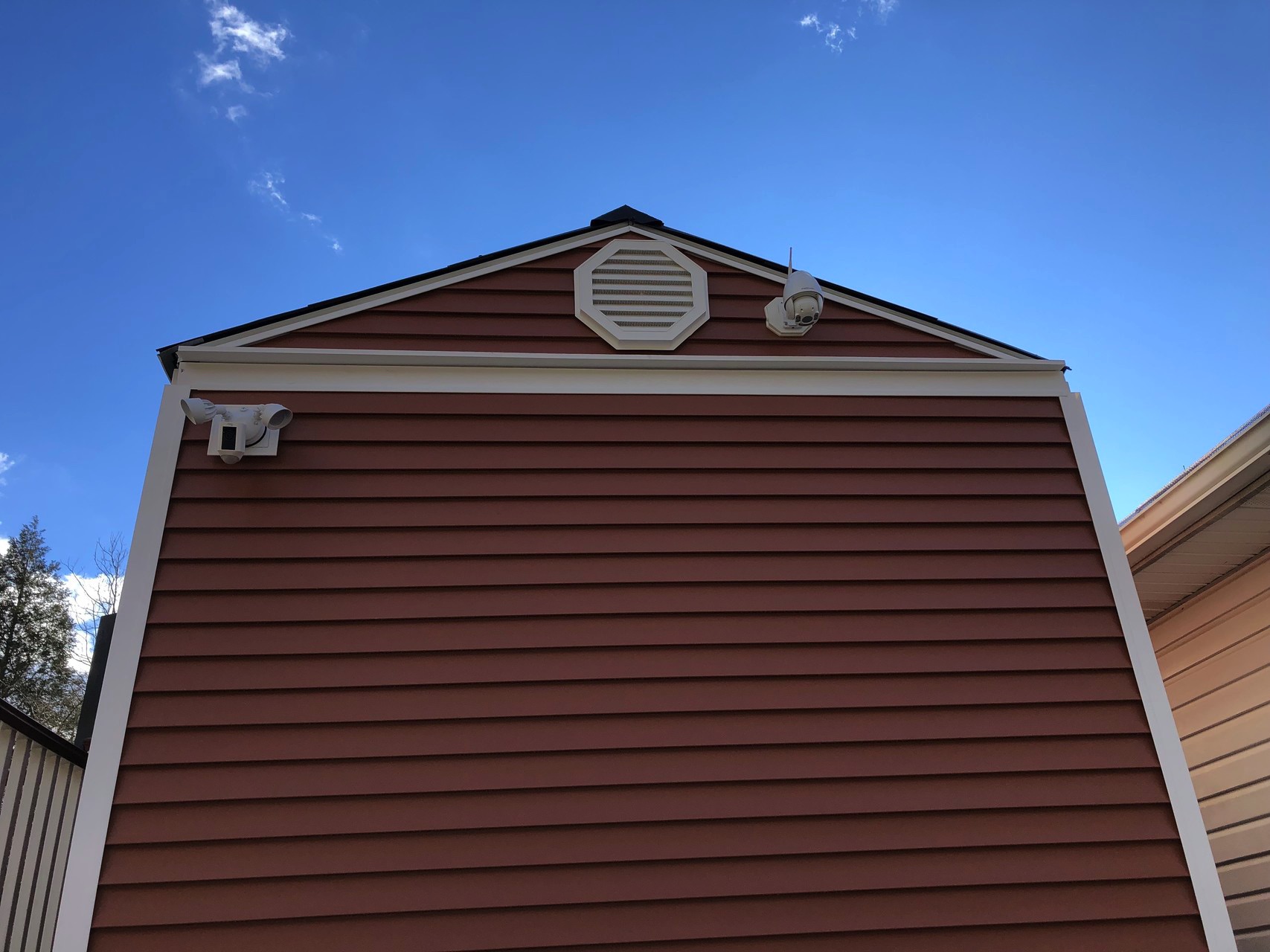

Outside Lights and Ring Cameras installed

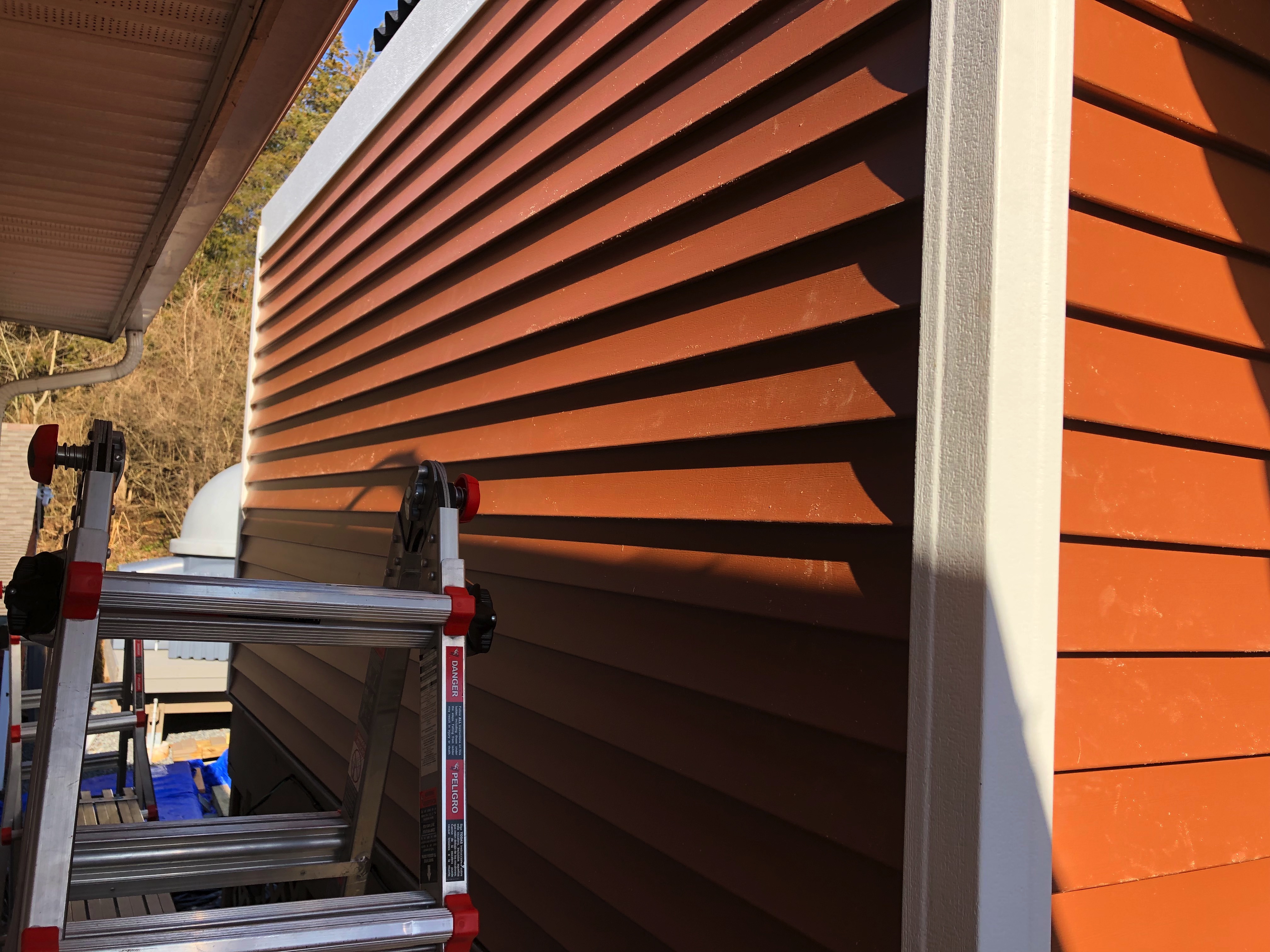

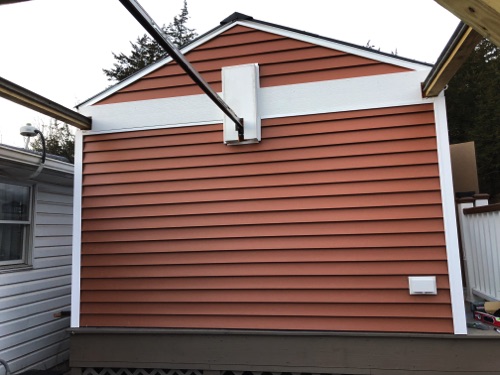

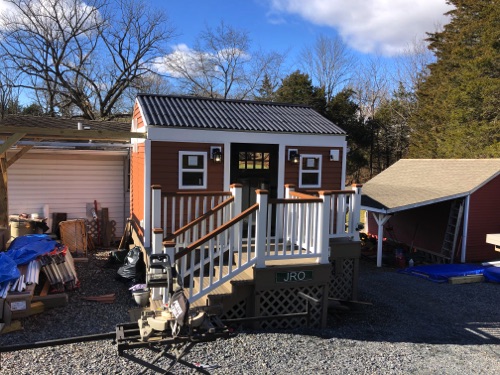

Siding Done

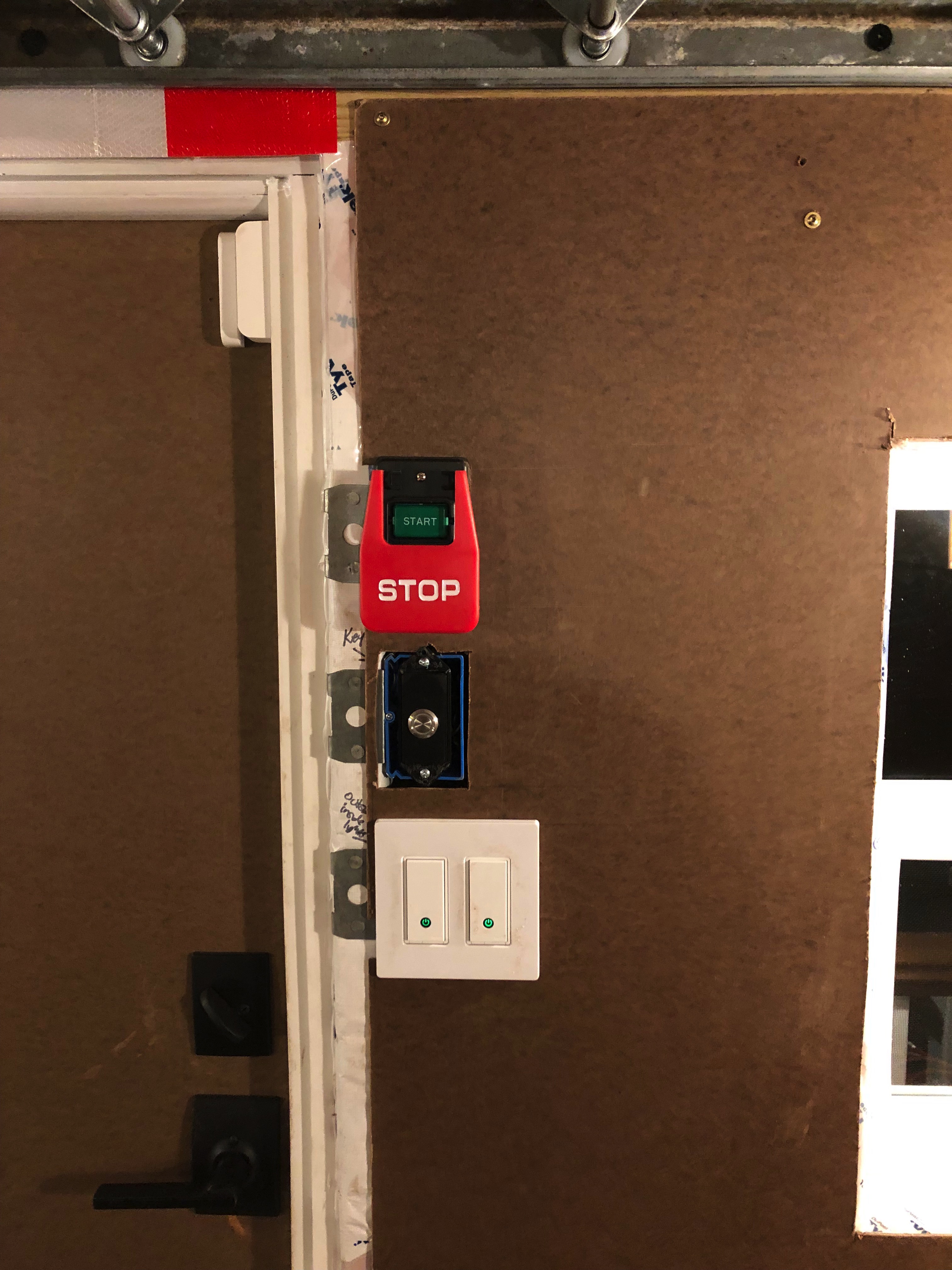

Roof automation complete - It opens and closes with a garage door opener. See videos below
Made cover for attachments, notched for cover
Mounted the garage door opener
Redo door jam in PVC

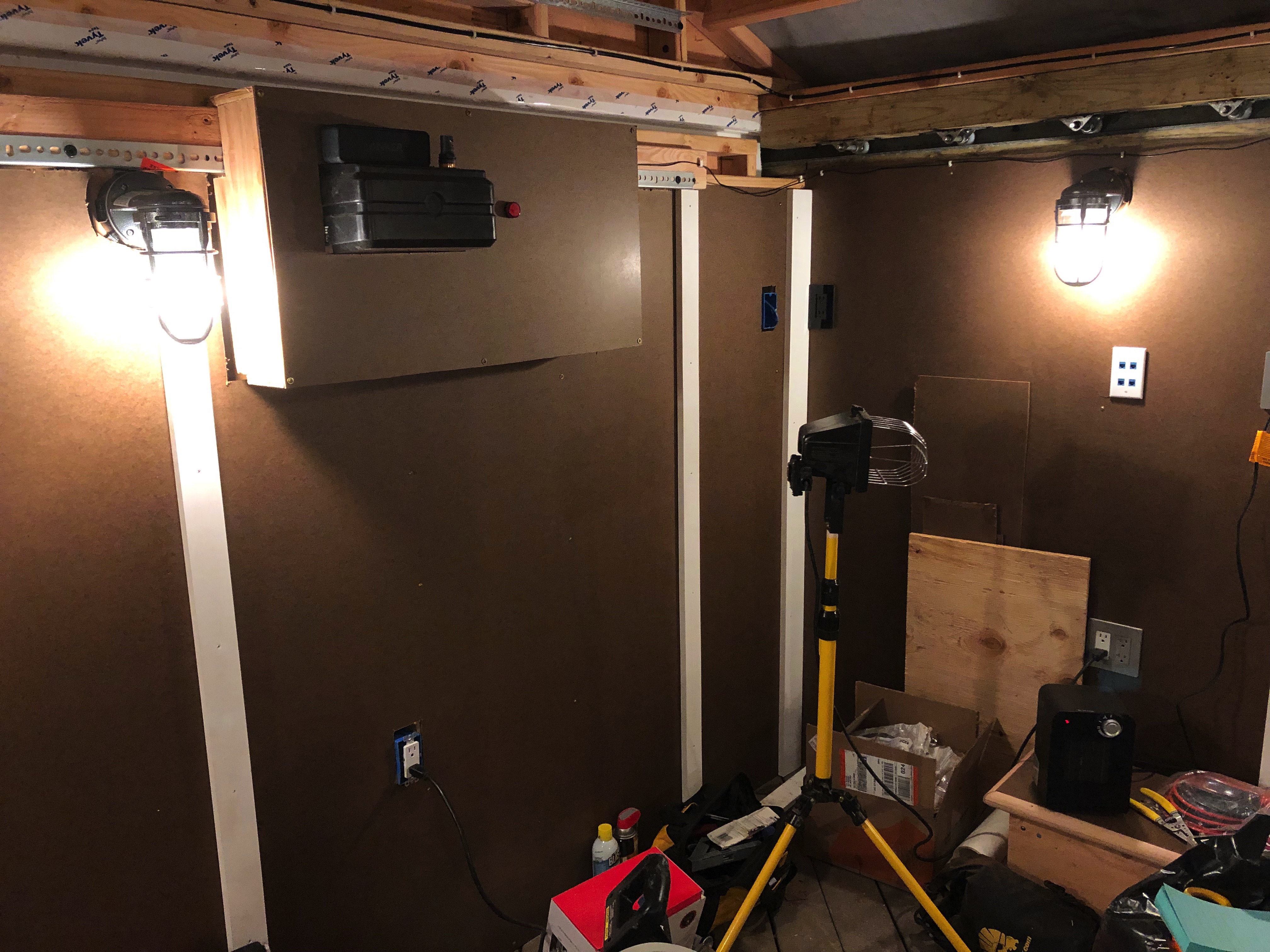

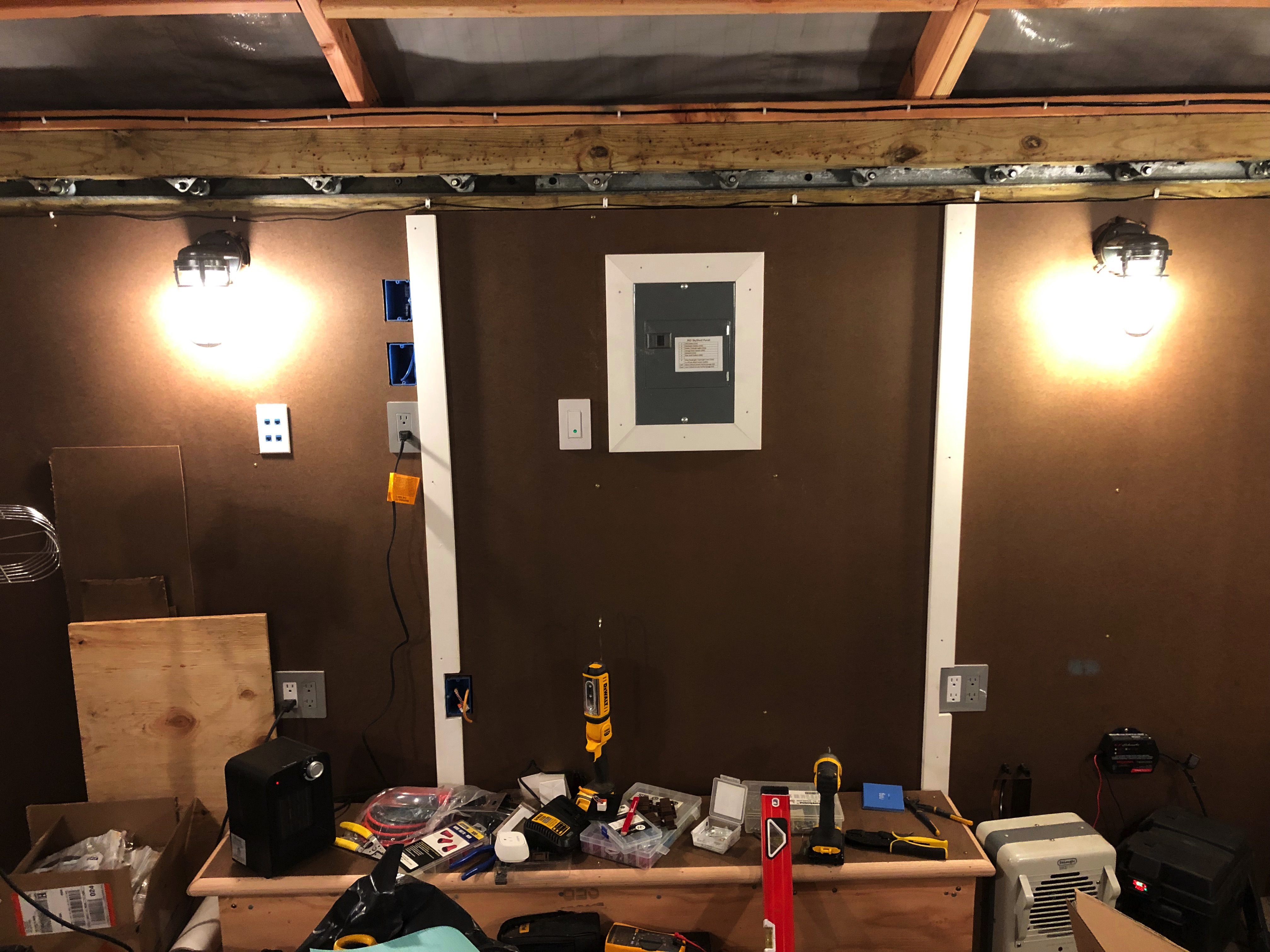

Finished Electrical
Finished off Ridge, installed ridge caps
Moved electrical & LAN services
Lowered Cross member to accommodate garage door screw drive

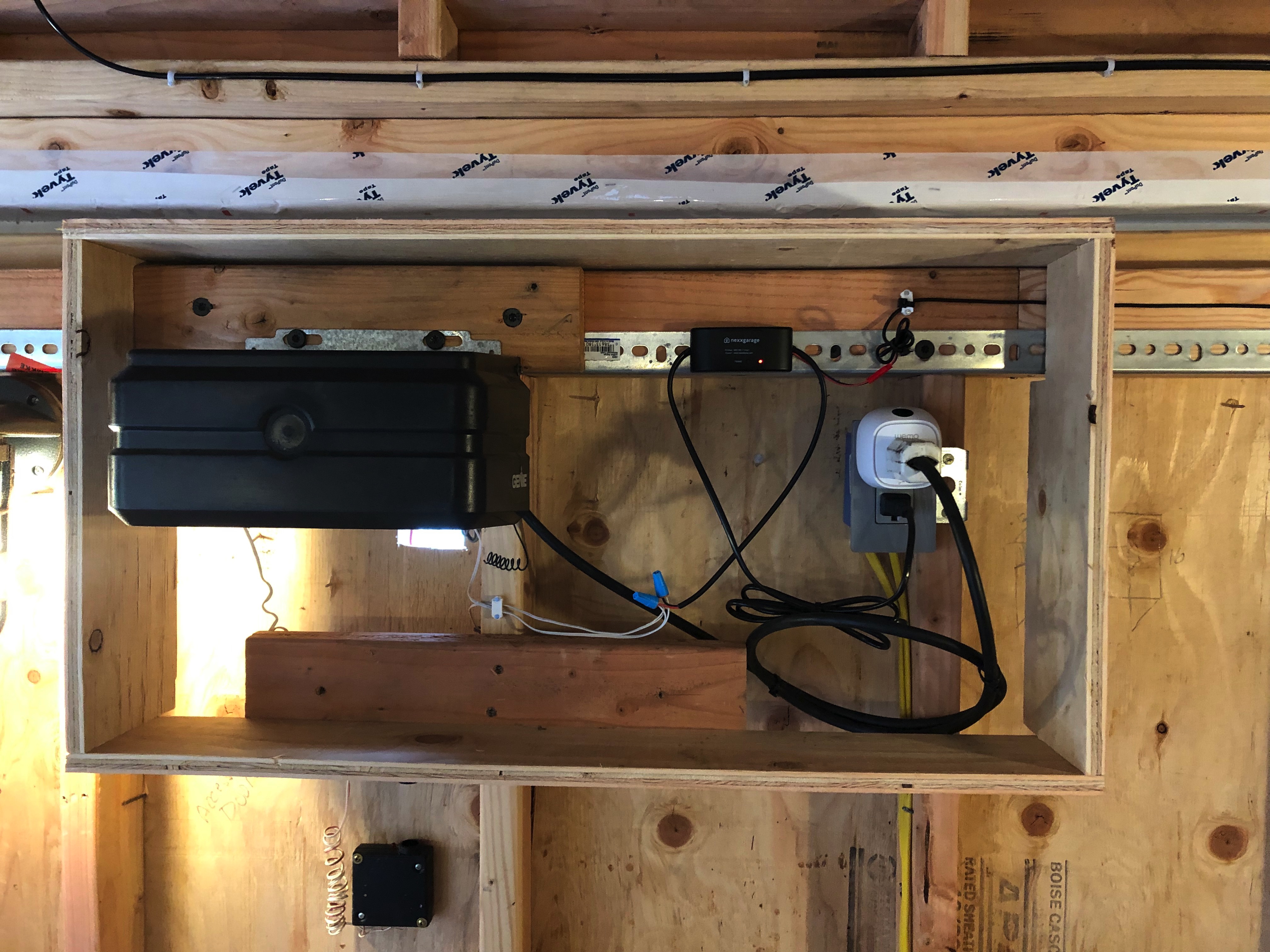

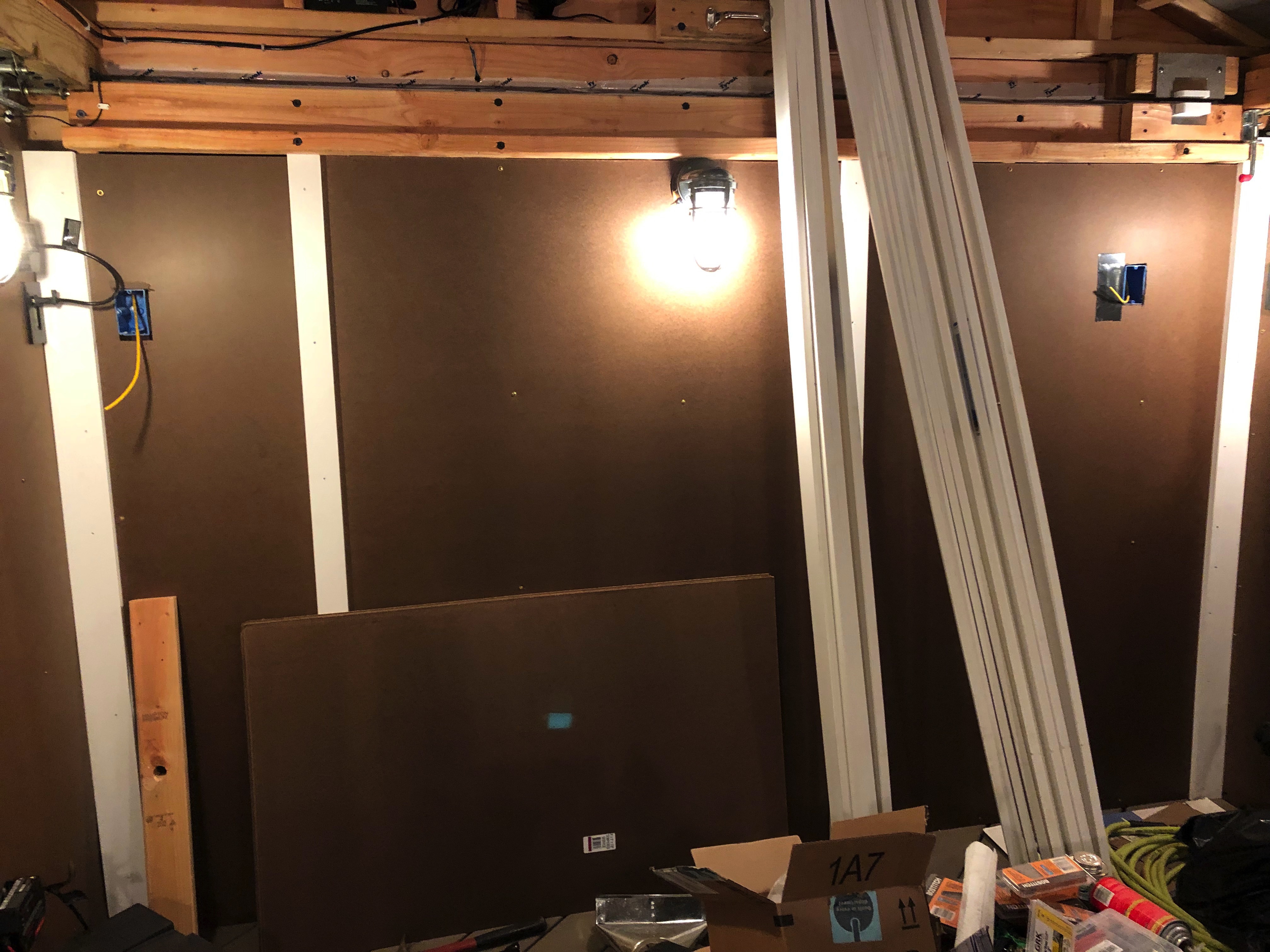

Electrical Rough in (300' 14x2 + 100' 12x2)

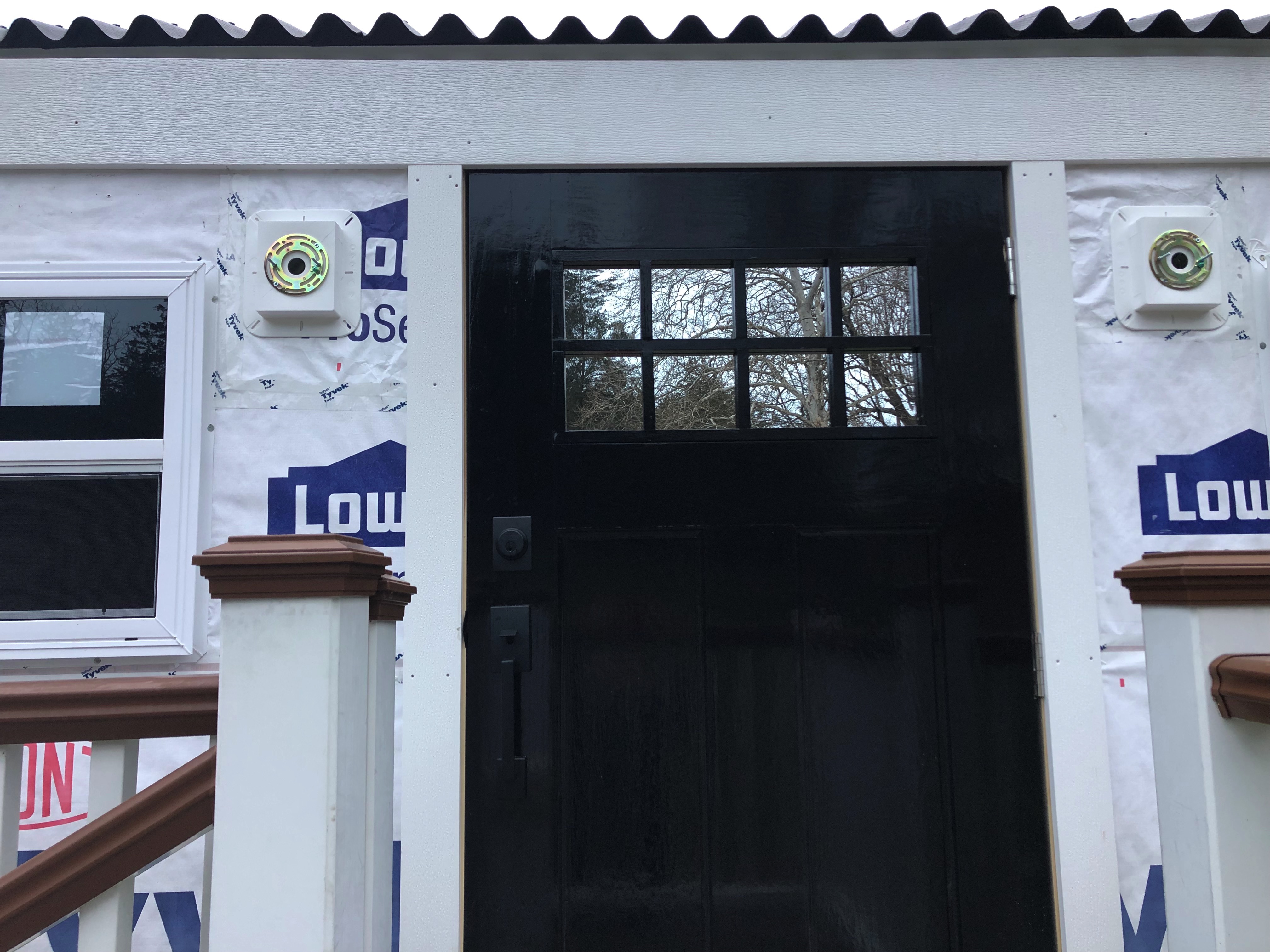

Taped Windows
Installed Gable vent
Installed Ring mounting blocks

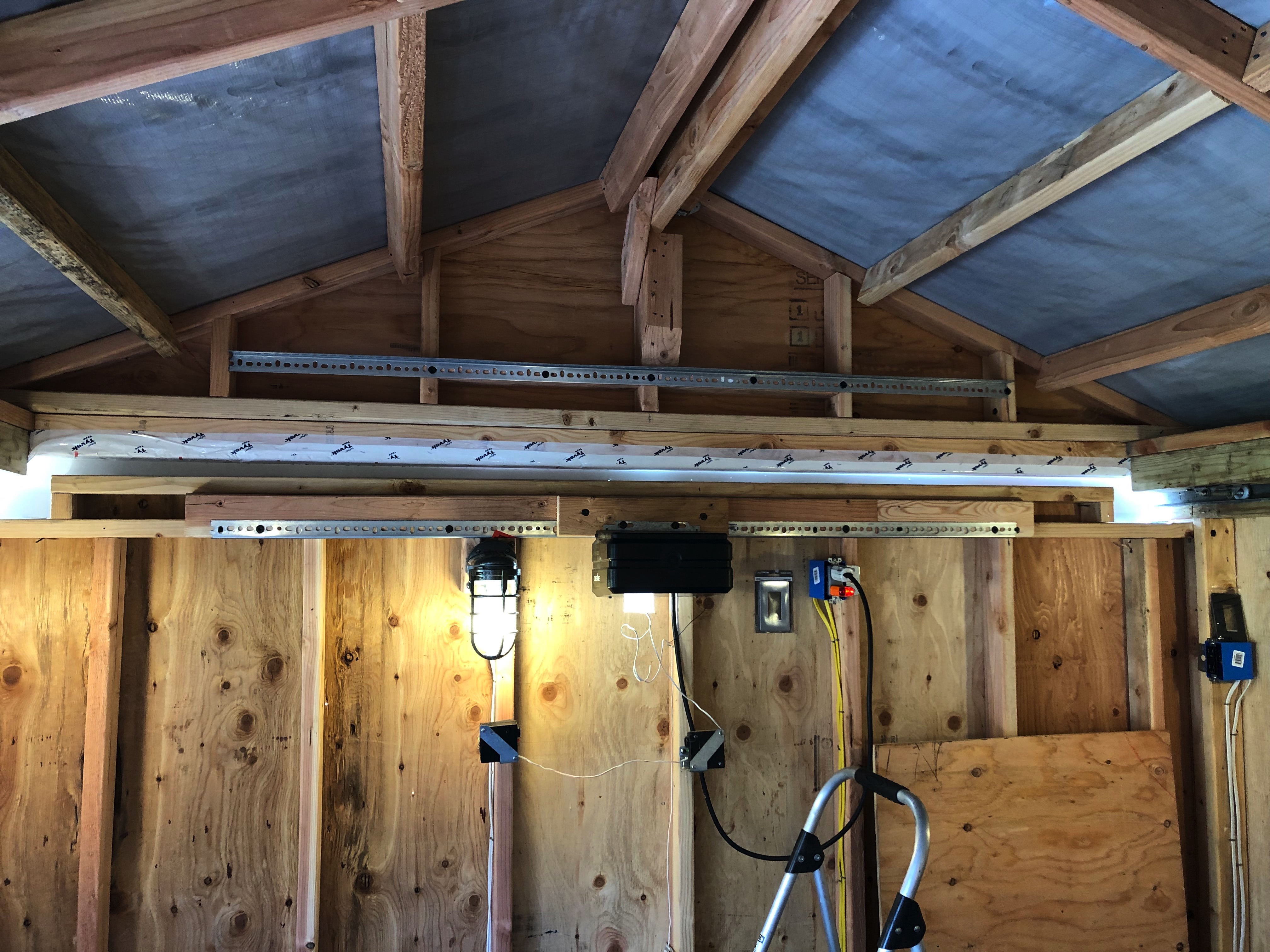

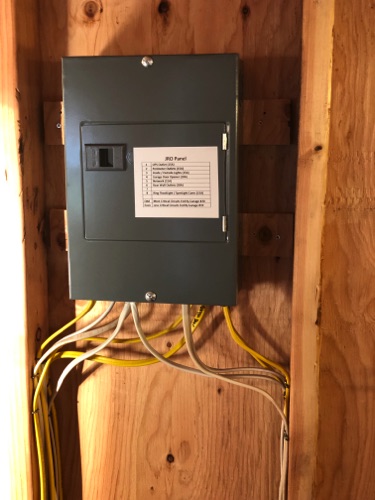

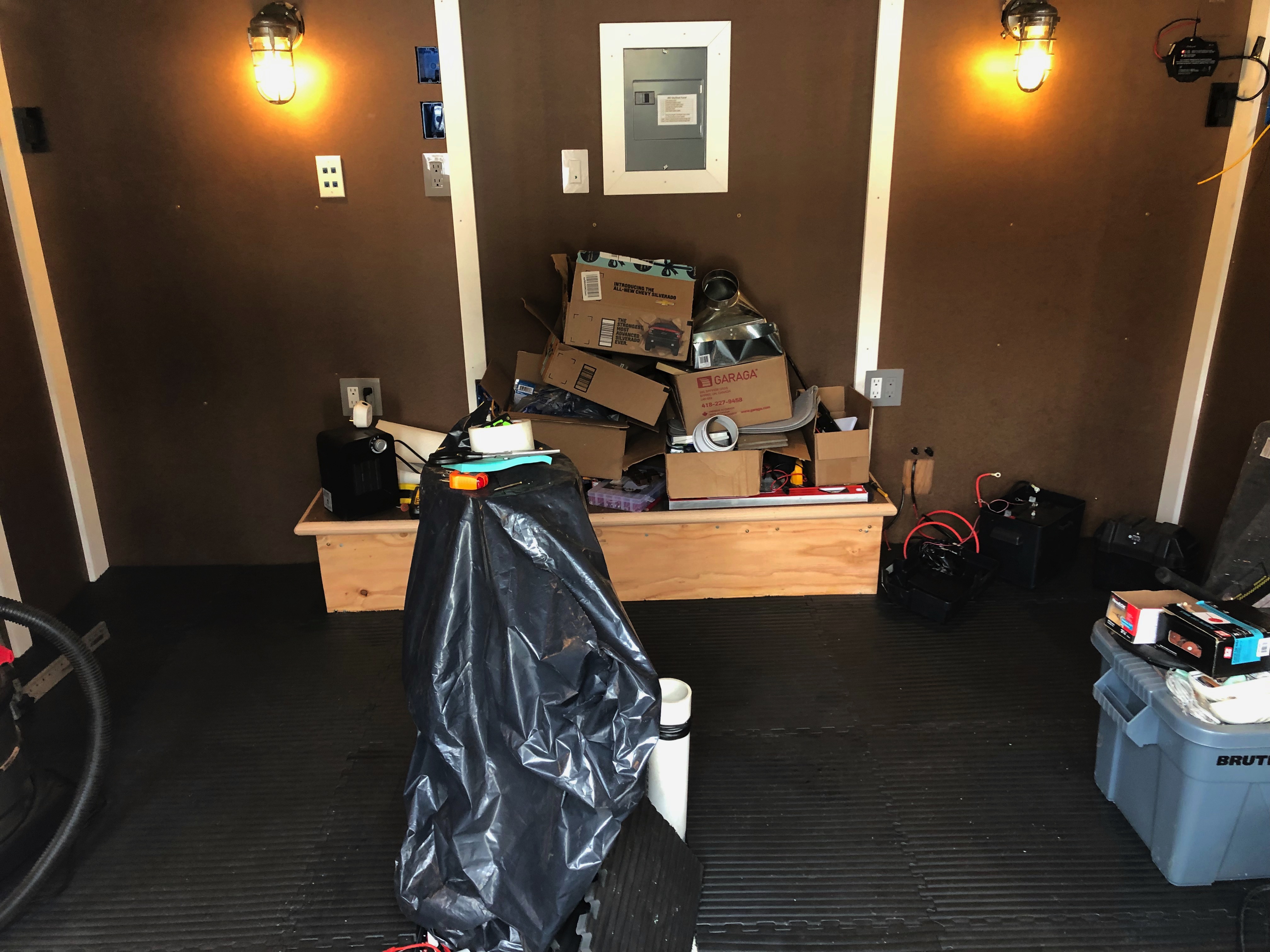

Installed Panel, hung all electrical boxes

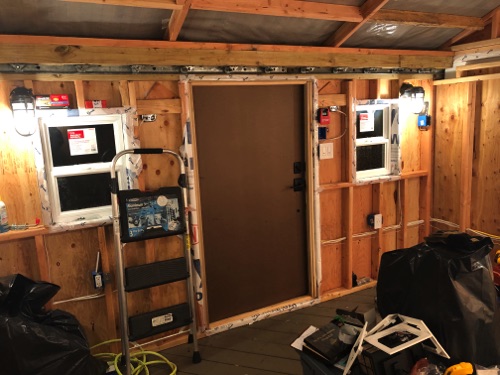

Finished Trimming out door
Installed weather protection valances
Install and trim out door with lock and door stop

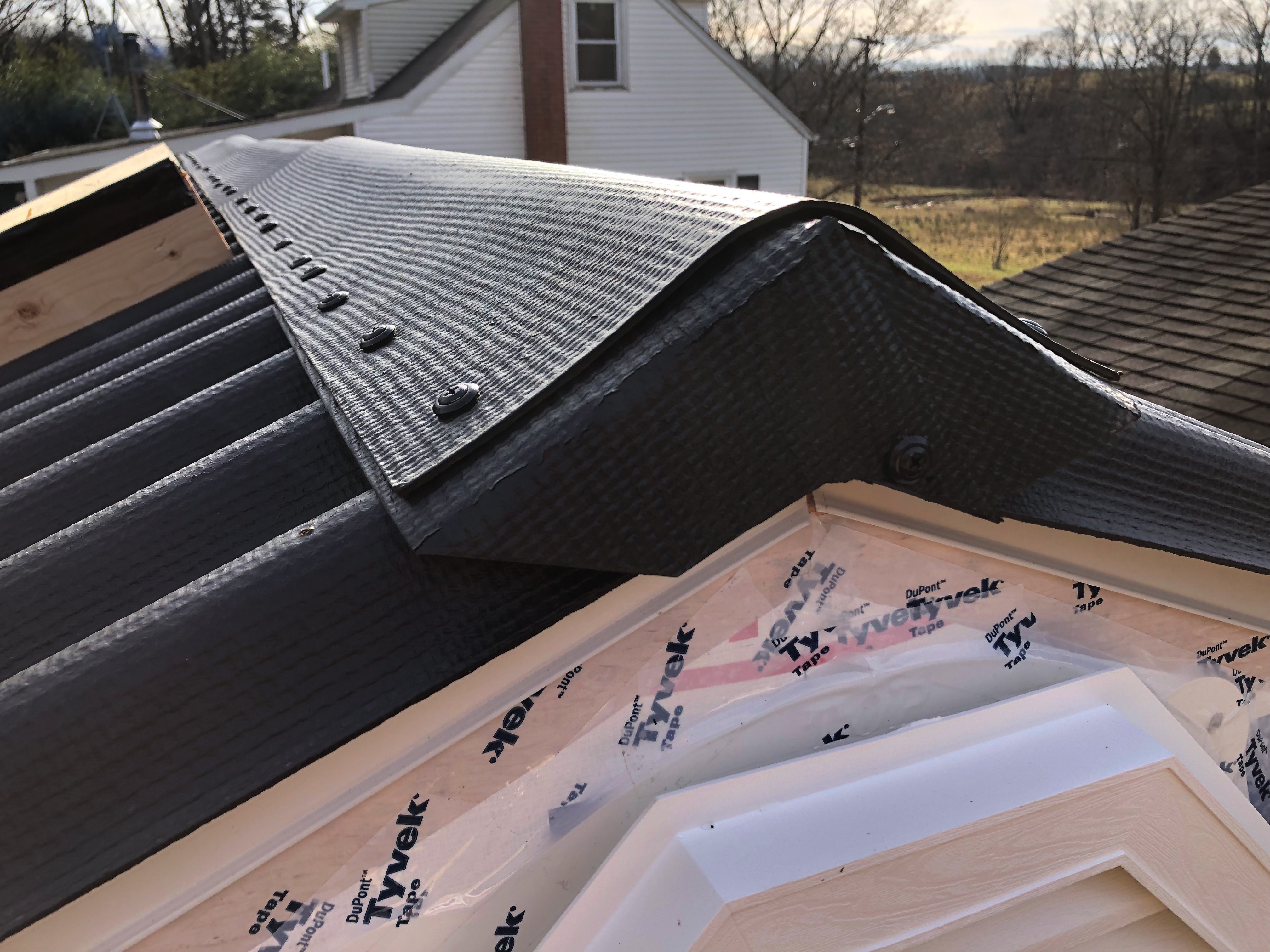

Completed Ondura roof including ridge
Installed drip edge and 1/2 of the Ondura roof

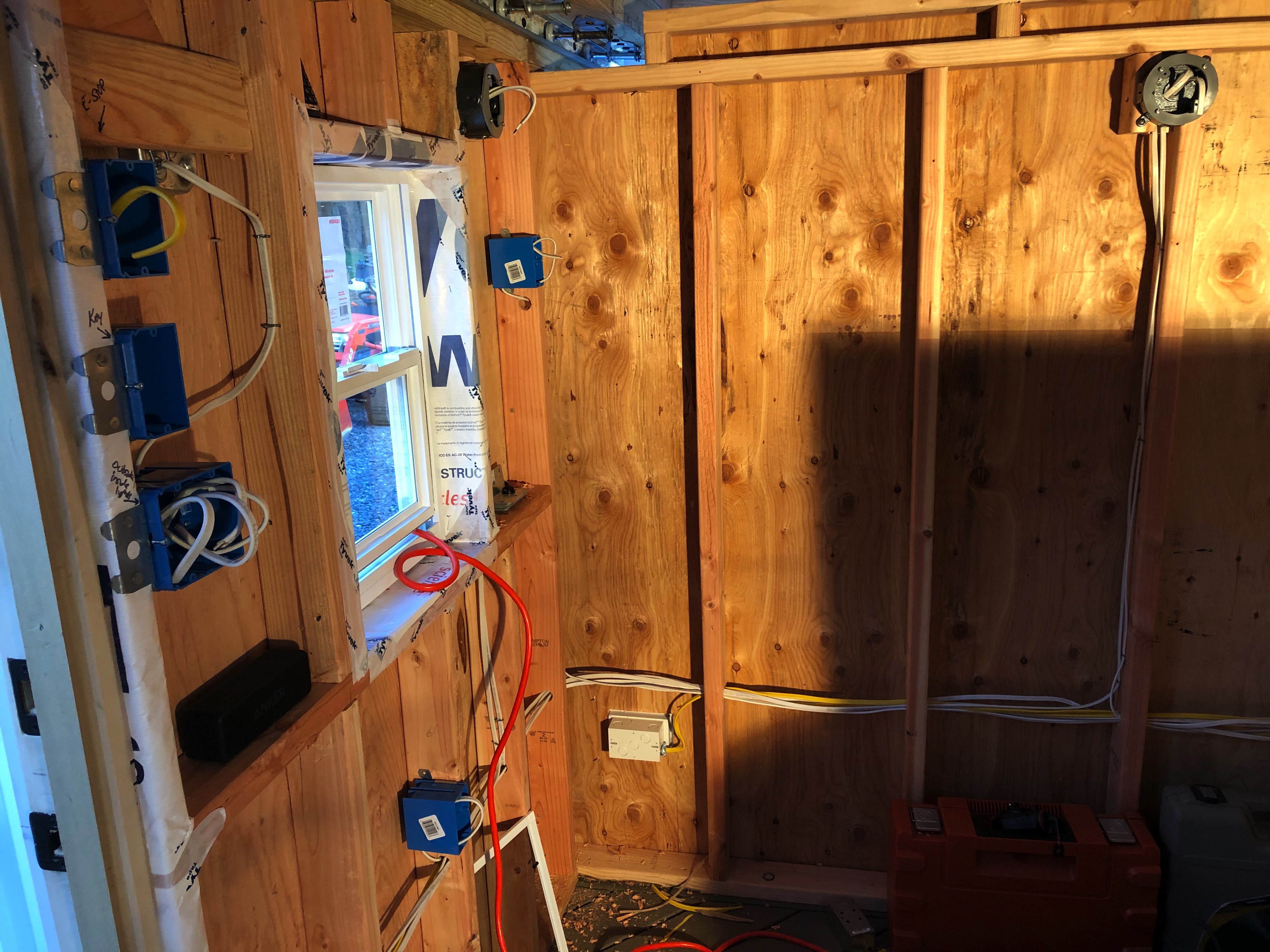

Started Electrical inside the SkyShed

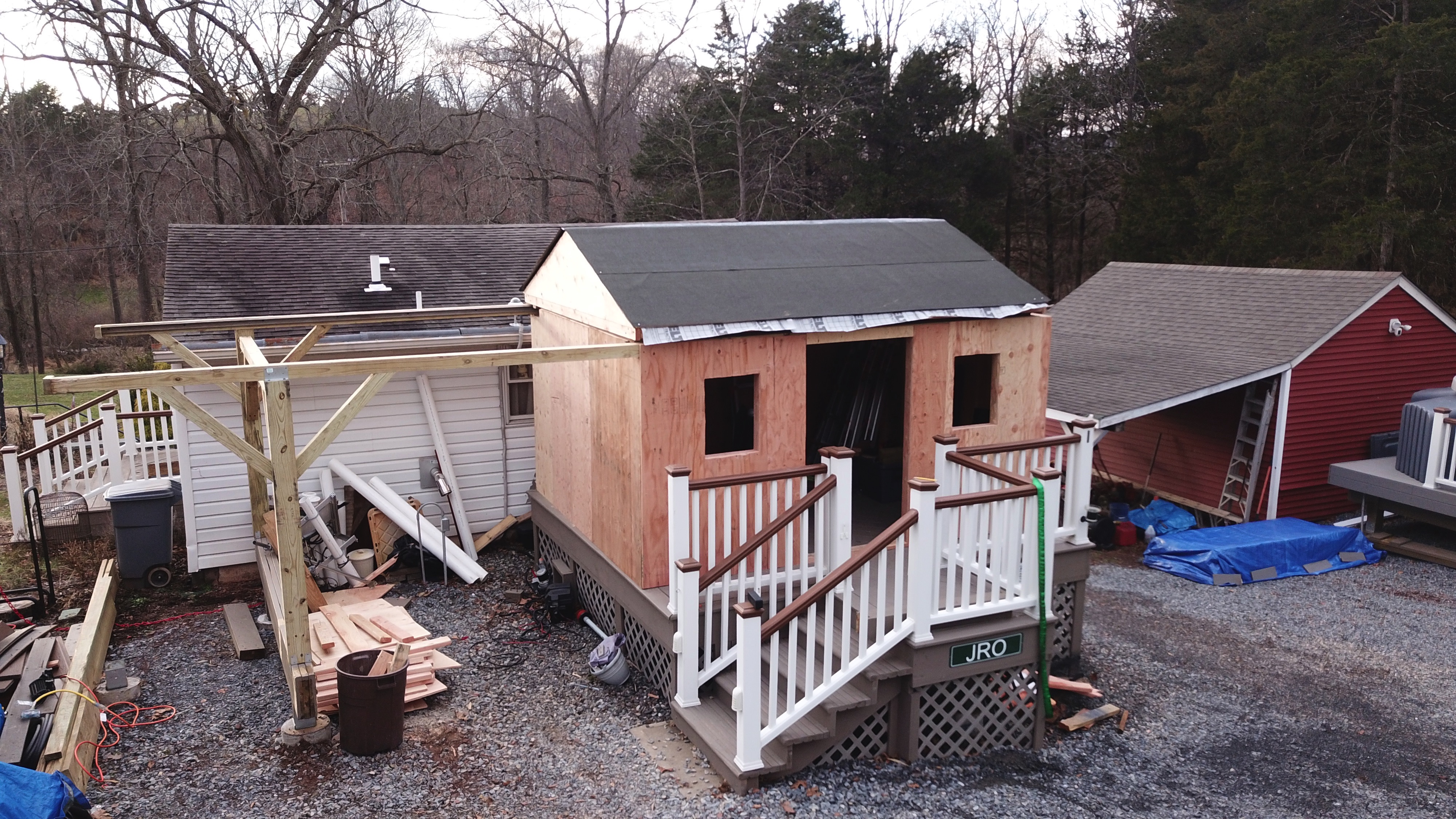

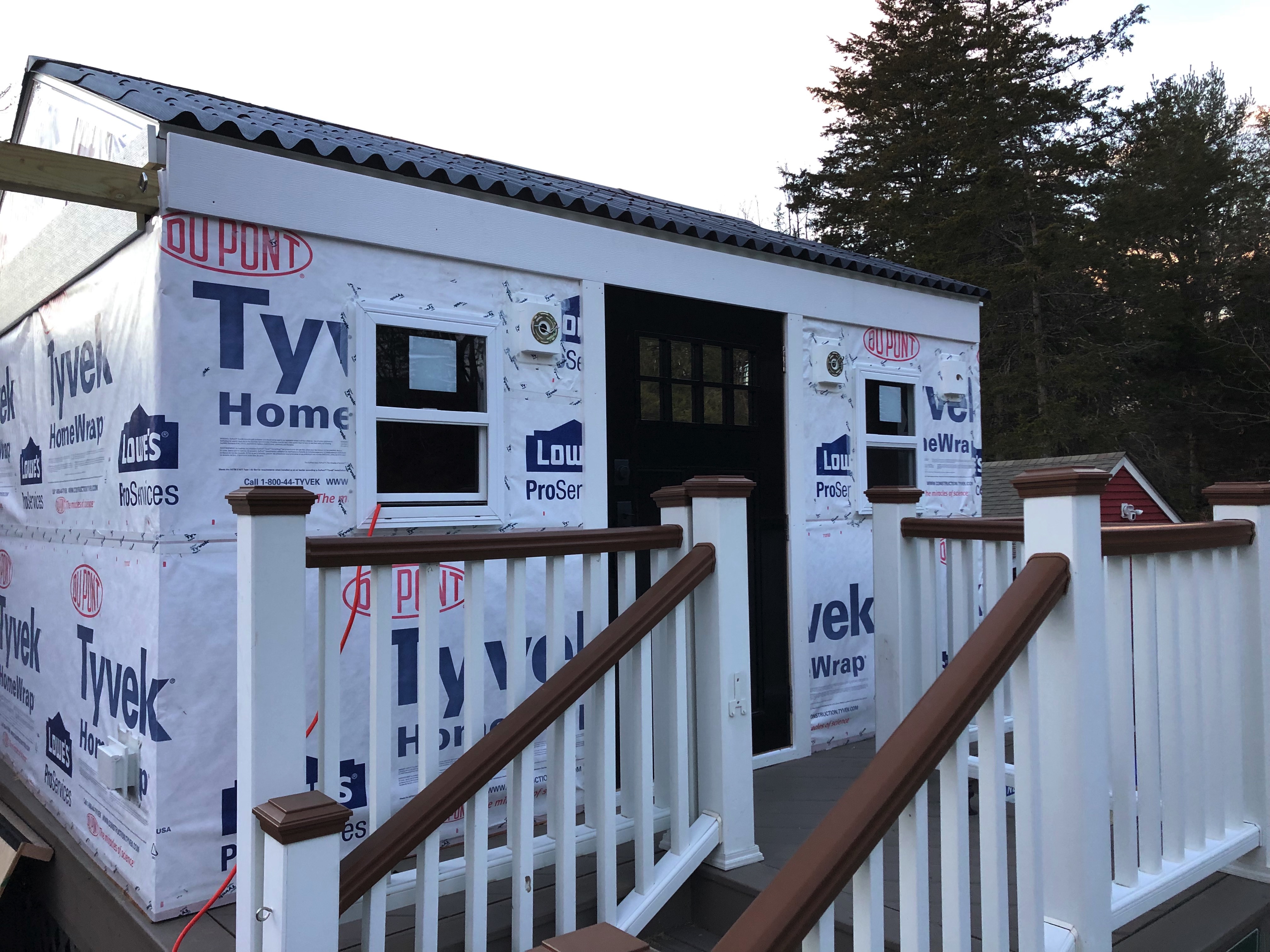

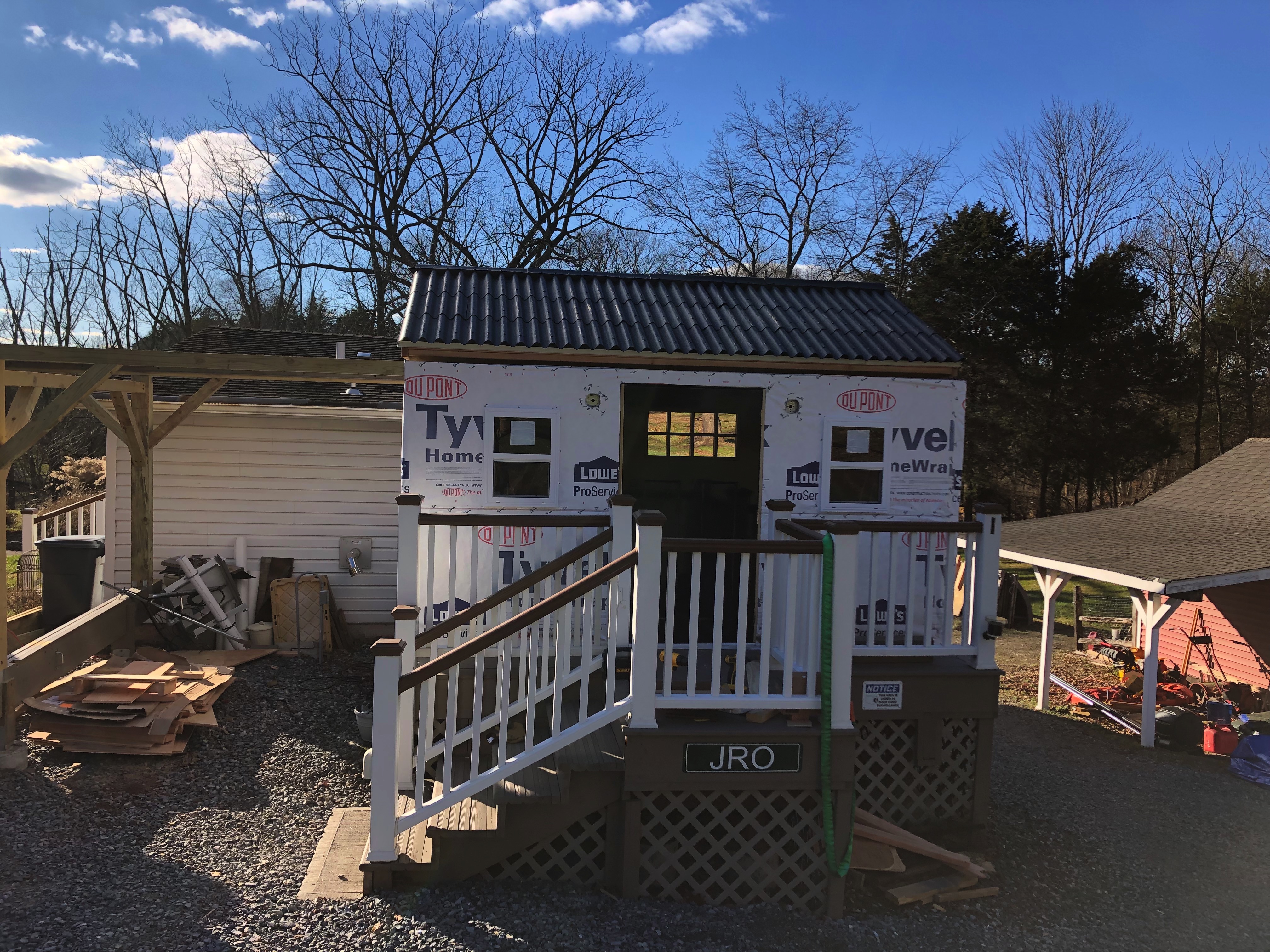

Installed Tyvek wrap and windows
November 10 -

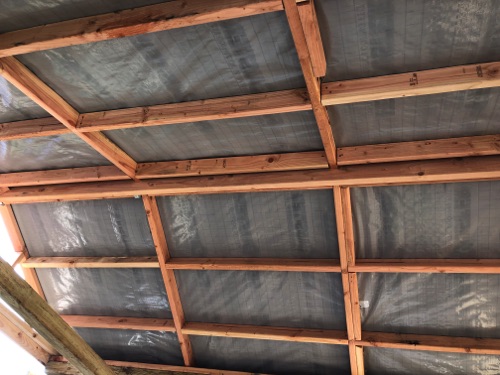

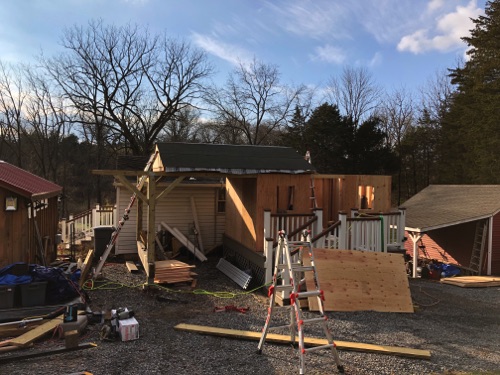

Roof foundation + prep -Ready for Ondura Roof!

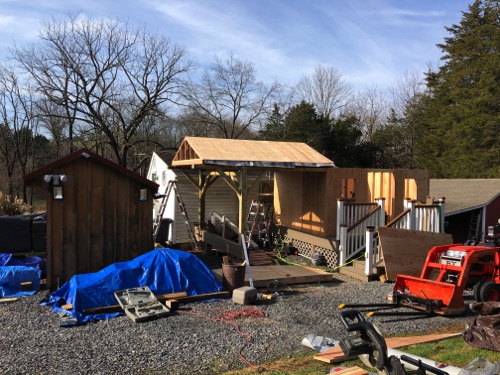

Finished framing the roof, buttoned up for rain this afternoon, drilled the door for locks
Installed all the roll-off wheels

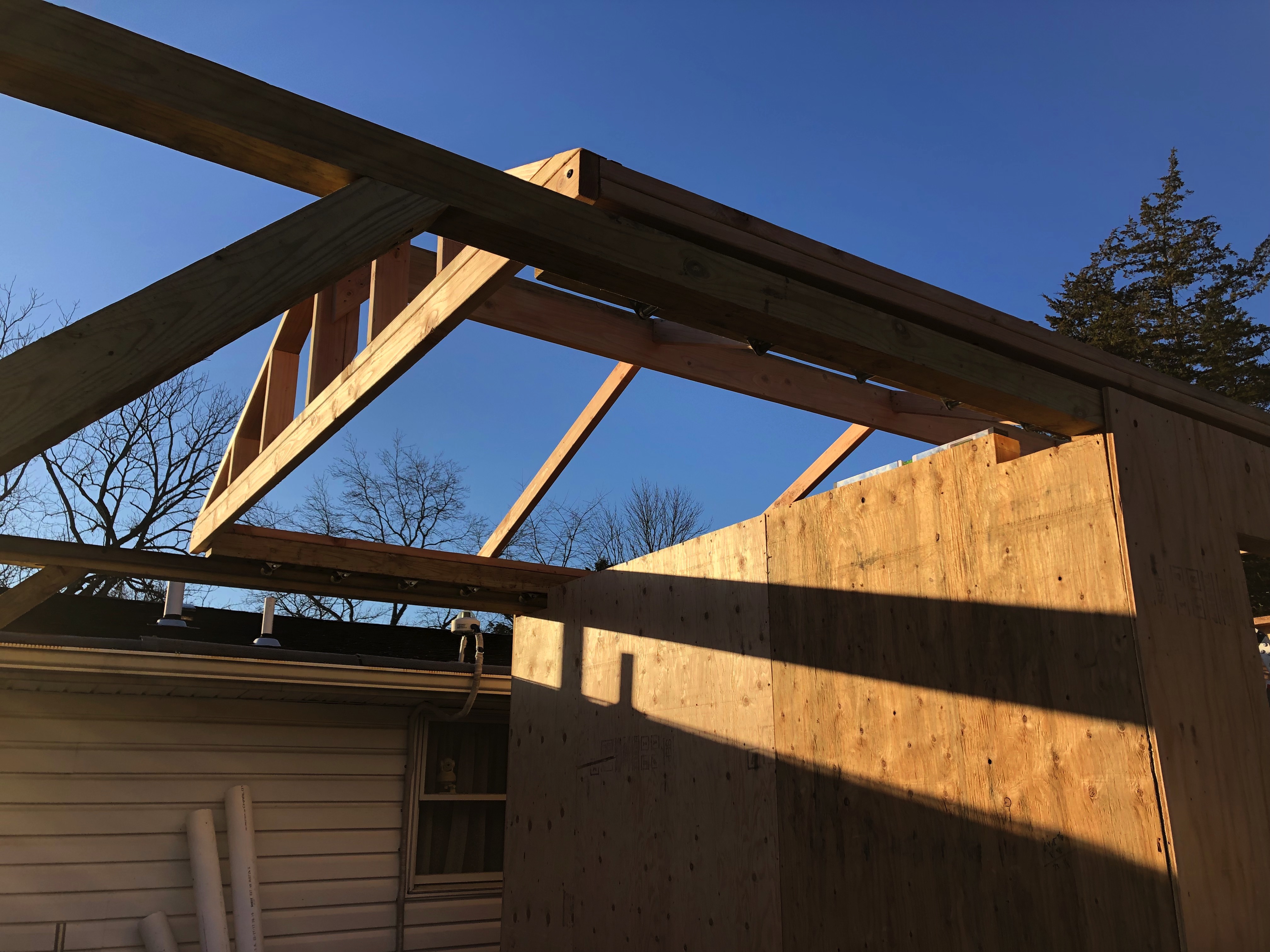

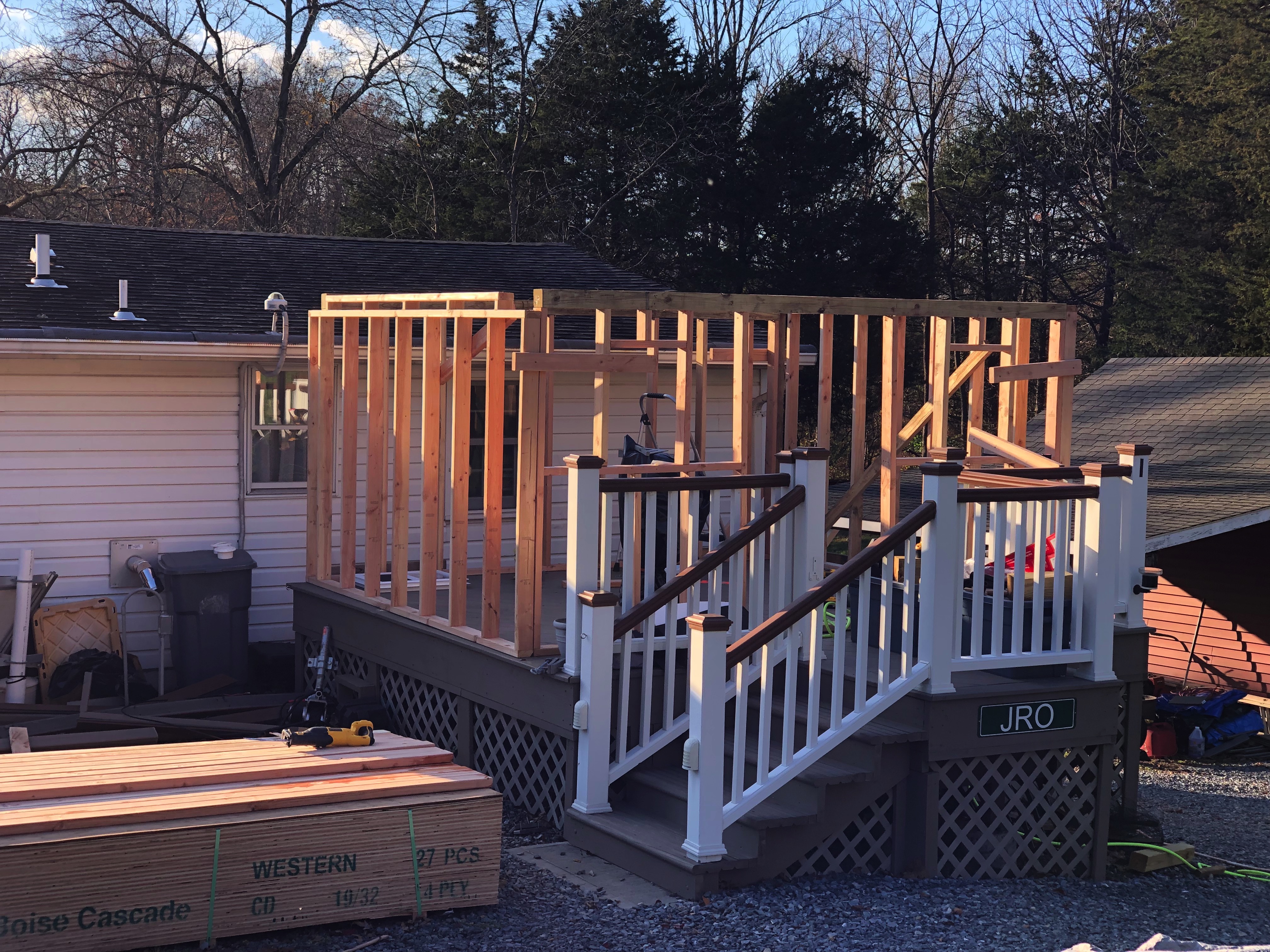

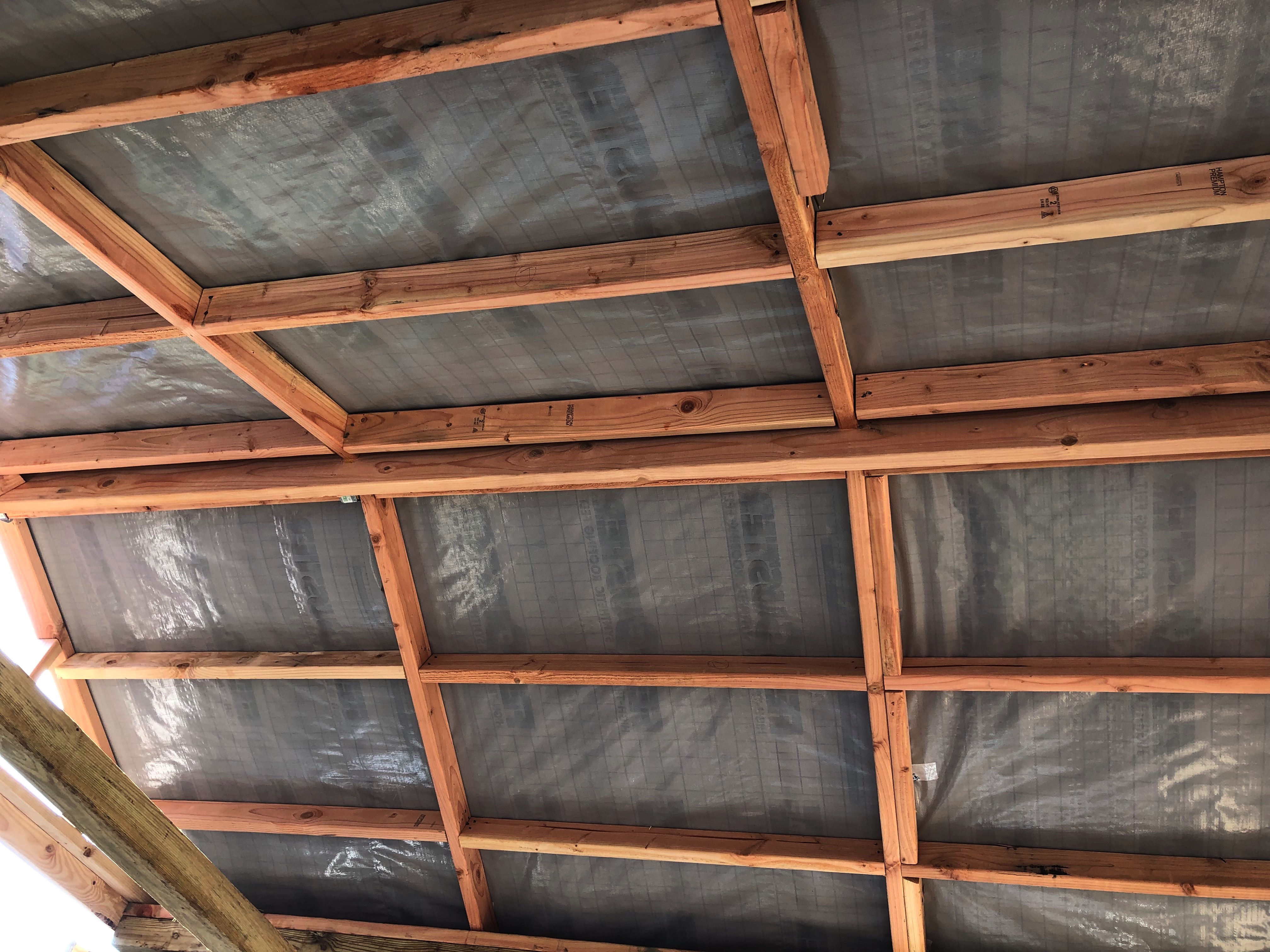

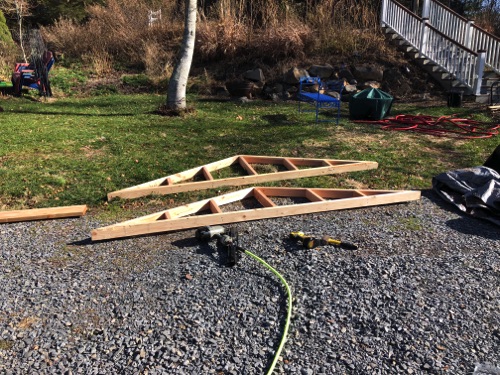

Made Trusses, installed with ridge

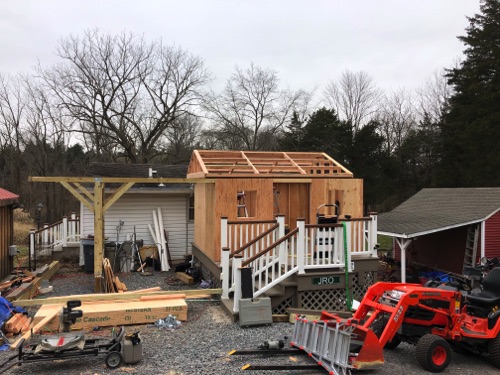

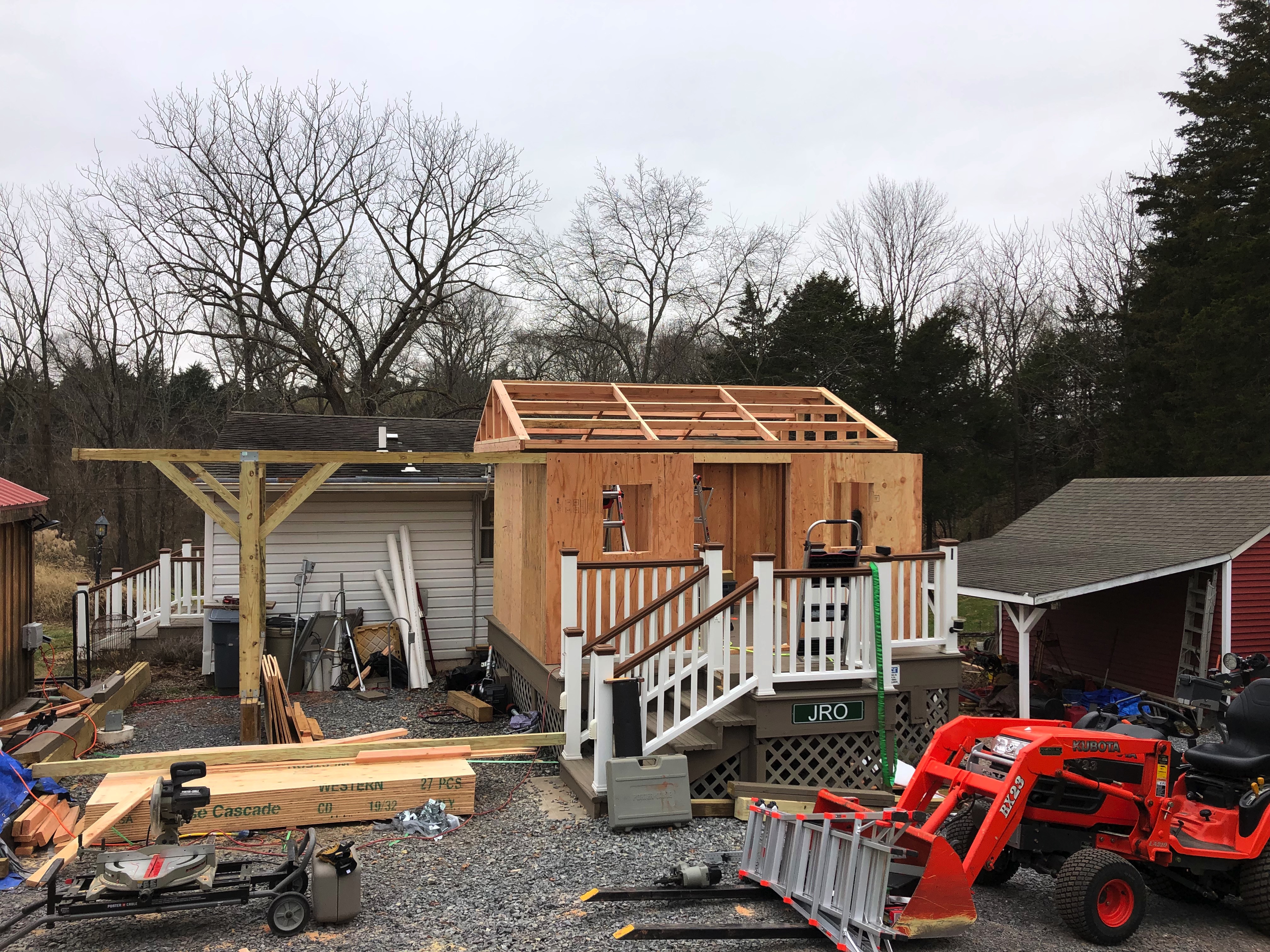

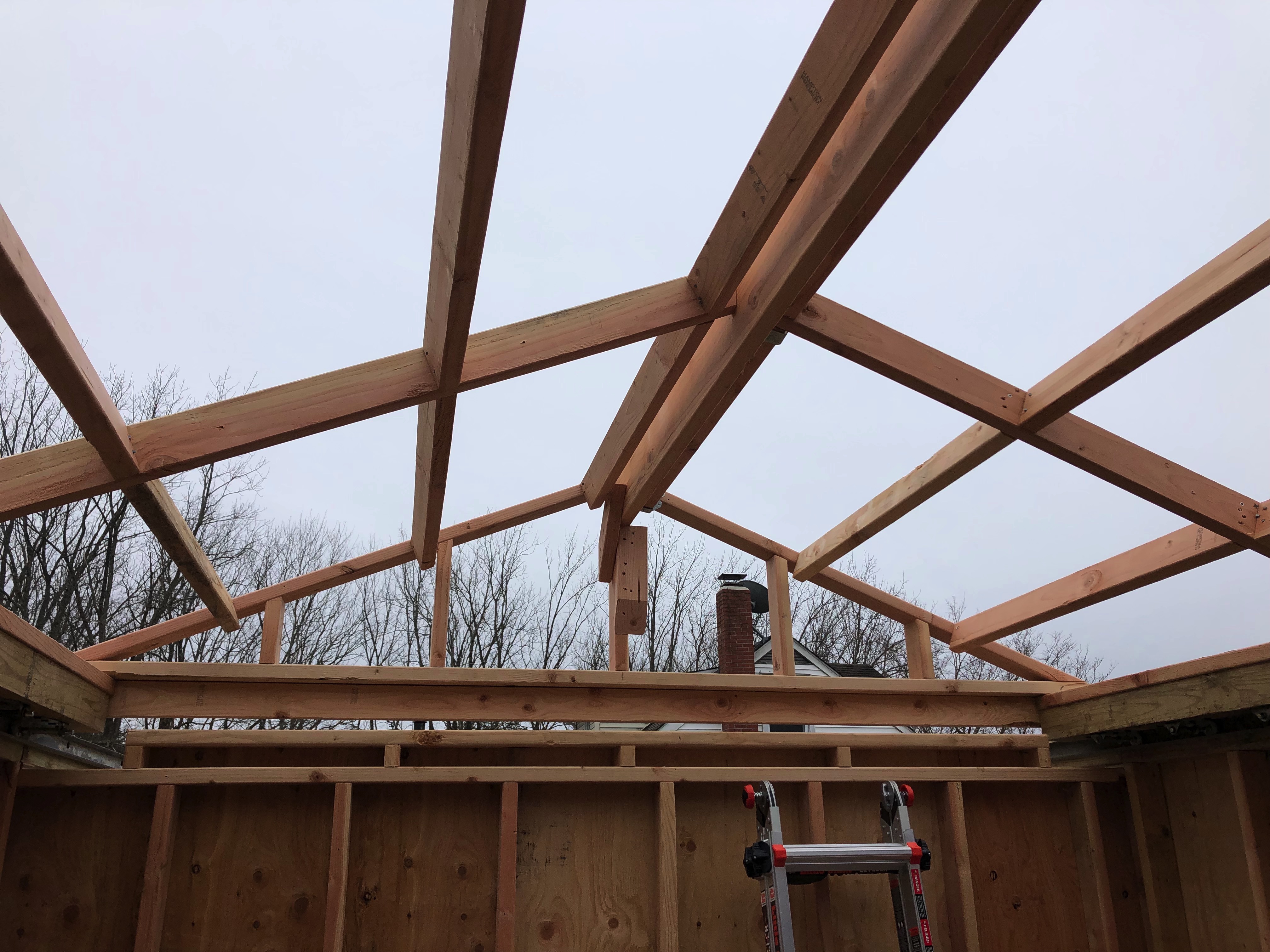

Started Framing Roof -was 9 degrees when I started this morning!
Installed 2 collar ties (so cold & Thanksgiving)
Roof Runners installed and connected
2" Garage Door Track installed
Finished Rolloff Rails, built Roof Runners

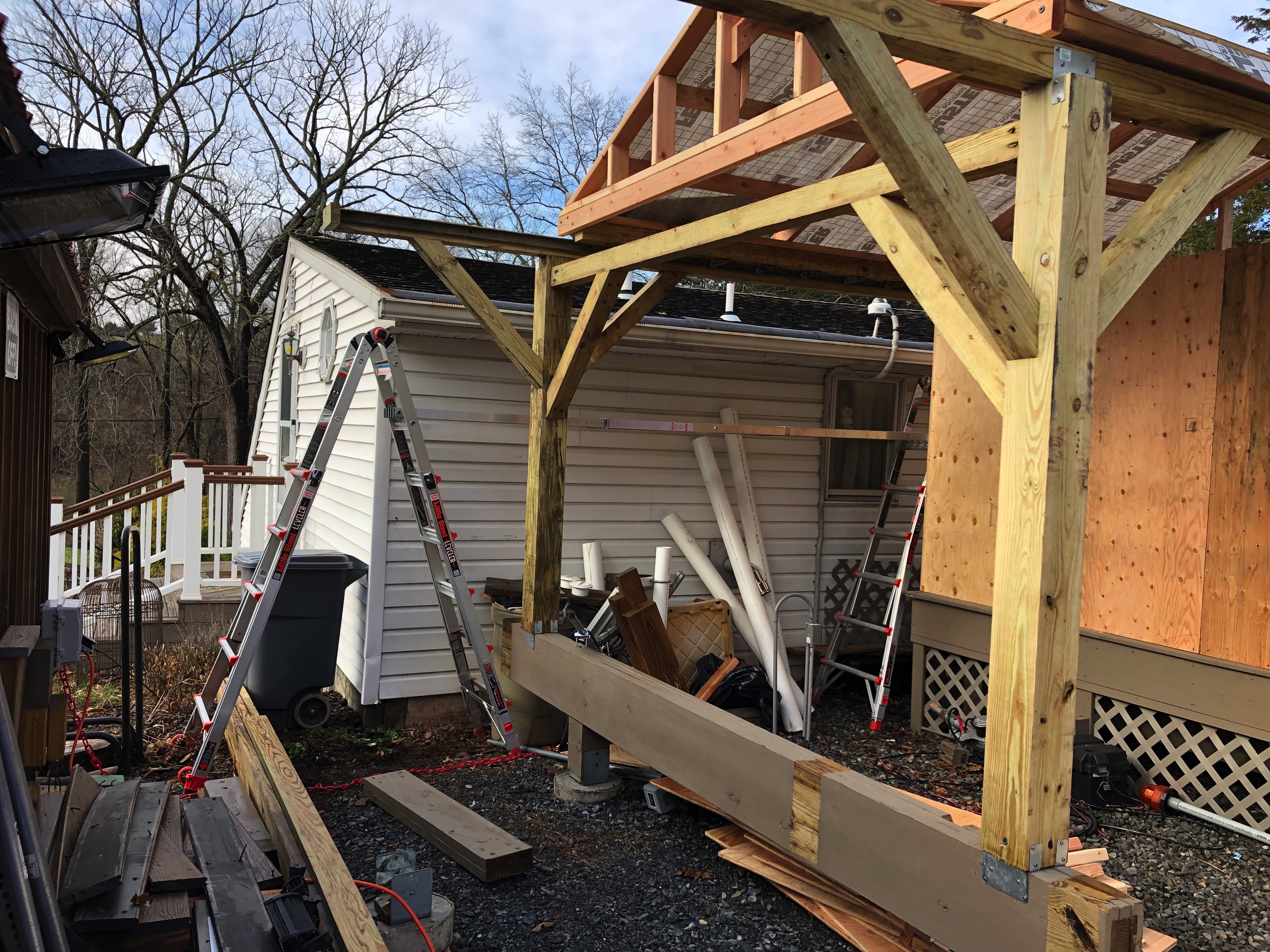

Despite snow, I Installed the beam, posts and rolloff rails
Covered all 4 walls in playwood, sanded and painted door

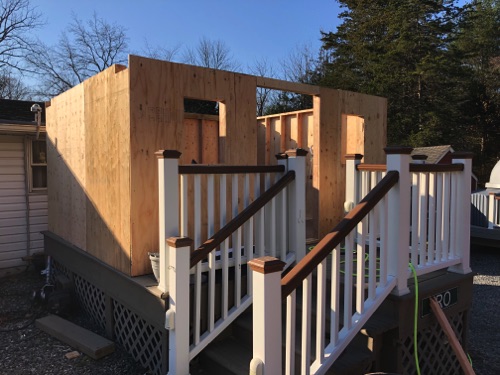

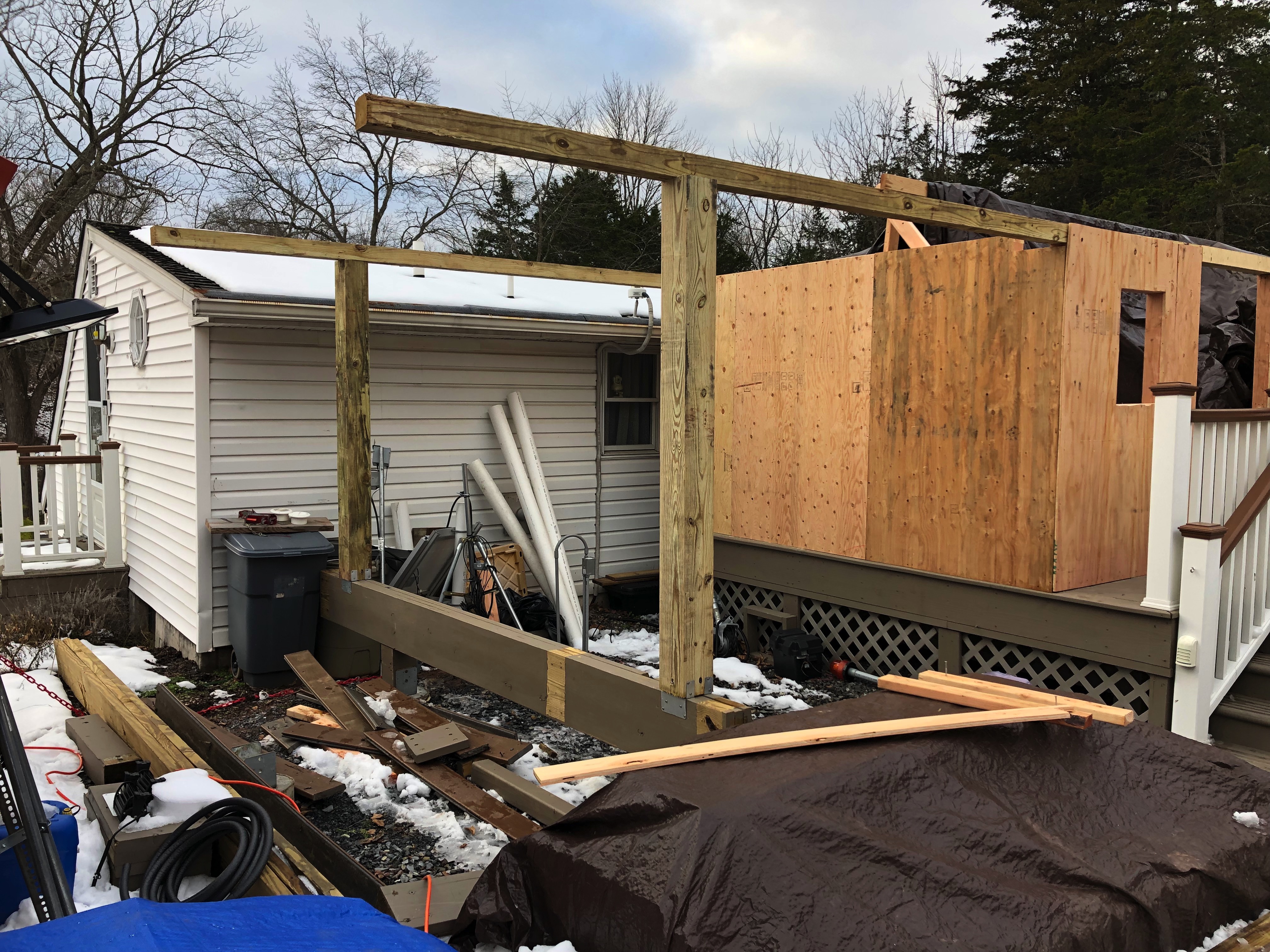

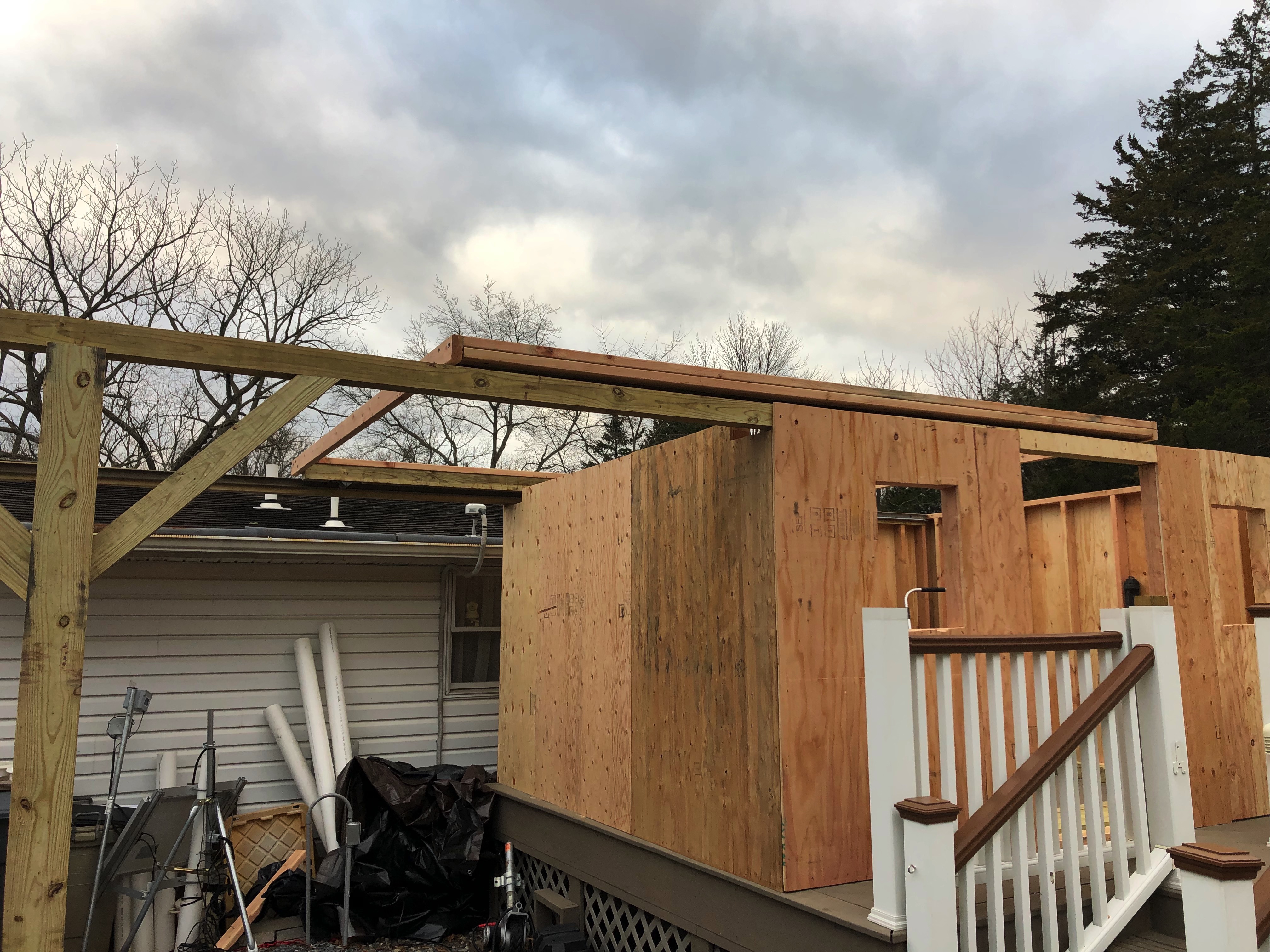

Built and erected the 4 walls
Started painting the door
Late October

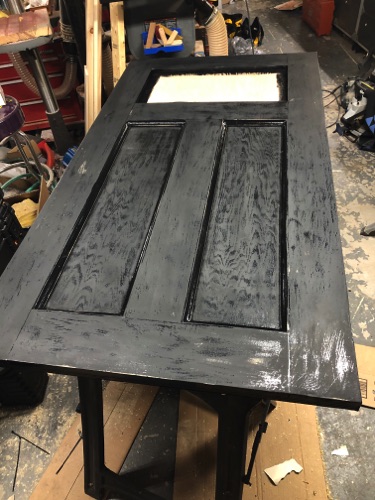

Sanding Door, prep for paint
All materials on hand except the siding
Late September 2018
Finished the door rough construction, filled holes, added the back
Started the door
